LFPB/Paris Le Bourget is one of the airports people always want to know about, and we’ve got a bunch of recent OPSGROUP member reports from trips there.
Some trips went smoothly, but others came with things to watch out for: long waits for passport control, customs penalties for undeclared cash, thorough SAFA and police checks, confusing APU limits, and tricky arrivals.
Waiting for passport control
The latest issue in our LFPB reports is how passengers are processed within the FBO.
One crew reported their international passengers waited nearly 90 minutes for officers to arrive. When they did, they took each passenger into a private room one by one. Jetex says their passengers now hand over passports, give fingerprints, and have photos taken. Signature told us these checks used to happen in a police van on the ramp, but now they’re done inside the FBO since EES started.
FBOs say delays depend on when border police are available. Once officers arrive, it can take another 10 mins to set up their computers.
One crew waited 45 minutes for customs to come to the FBO so passengers could claim VAT refunds. Each passenger was then processed individually.
It’s hard to predict how long checks will take on any visit. If you’re short on time, leave some extra margin.
The cash story that ended in a fine

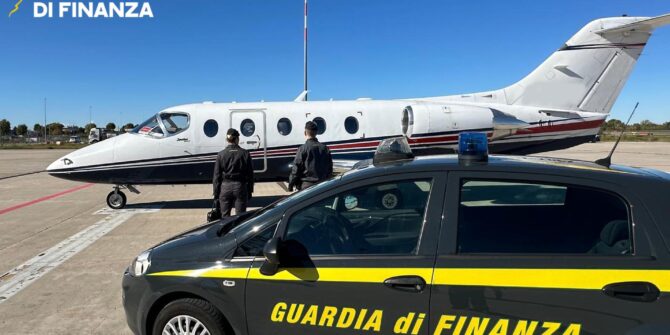

At first, this seemed like a typical customs delay: “We experienced a delay due to customs. PAX had to wait 15 minutes after they had arrived at the FBO for customs to arrive. They then took another 30 minutes to process 5 PAX. We eventually departed an hour behind schedule.”
But that wasn’t the end of it. Customs found over $10,000 in petty cash on board and imposed a penalty because it hadn’t been declared. The cash hadn’t left the aircraft the whole trip, but it still got hit with a 10% penalty! The aircraft couldn’t leave until this was resolved, which added another two hours to the delay.
So declare any cash in advance and be prepared to explain its source. They also said that bags left on board were searched by customs.
A closer look on the ramp

SAFA checks happen often enough at LFPB and can be thorough, but crews say the latest inspectors have been very professional and even “pleasant”.
One instance was of two inspectors turning up around an hour prior to departure and spending 30 minutes going through the docs, the FPL, the QRH and cabin safety equipment. They also asked about the oceanic planning. Another crew had a very similar 30 min check. The inspectors were very practical in their feedback and gave some very useful tips on how to find the docs on the iPad.
Another member said the French police checked to see whether a flight was in fact private rather than commercial. They looked at the fuel docs, went into the cabin and asked a passenger to confirm that they were the owner.
Keep all your paperwork together and easy to access. You can read more about these checks in our Paris Ramp Checks article.
APU rules
APU rules come up often in reports, and the official limits depend on your stand. If ground air and power are available, APU use is limited to 10 mins before departure and 5 mins after arrival. If they aren’t, the limits are 45 mins before departure and 20 mins after arrival. It can get a little confusing when FBOs have mobile GPUs, so check with them which limit applies to your stand.
Member reports:
2025 report: 60 minutes of APU use before departure, with crews expected to use a GPU.
Feb 2026: 10 minutes before departure and 5 minutes after arrival, matching the limits for a stand with ground air and power. However, their Gulfstream had electrical issues when started on external power.
The local police checks APU use, and ACNUSA (the Airport Nuisance Authority) can issue fines of up to €20,000. Both the operator and the PIC may be liable. A few safety exemptions are available, but you’ll need to explain why they apply.
Hot weather makes these restrictions harder to manage. During a 2026 heatwave, one FBO got special permission for extra APU time on a case-by-case basis. Check with your handler for the latest limits, especially in hot weather, and arrange a GPU for departure. For more on the rules, exemptions, and fines, see our article.
Brief the arrival
Always review the arrival sequence before you get there. On one VELOL 9E arrival, the crew wasn’t sure which of the five options they’d get. They asked ATC and were vectored to final. Another flight went from VELOL to KOLIV, joined the KOLIV initial, and then the ILS.
Paris traffic can also often mean speed reductions and a steep or late descent. One crew described a slam-dunk arrival, while another slowed significantly to fit in with traffic to CDG.
Check the latest runway conditions before arrival too. Reports mention wet conditions, birds, nearby VFR traffic, and braking action that was worse than expected. One Falcon 900 crew skipped the midfield exit to avoid heavy braking.
A Smooth Visit, with a Customs Delay on Departure
October 2026 | GLF5 “Our arrival from LFMN was straightforward. We had no customs formalities on arrival, and the FBO team was excellent. Overall, it was a positive experience, apart from the delay waiting for customs.”
Don’t Let the Arrival Catch You Off Guard
April 2026 | GLEX “ATC was surprisingly smooth. No complaints. The Flight Pro rep went above and beyond. Ramp was easy, parking was no issue, and customs/immigration was completely smooth with no friction.”
Easy to Use
June 2026 | F900 “The FBO is right there so it is easily walkable. Luggage was transported by the handler. Inbound: None for crew on arrival.”
Another Paris option: LFPM/Villaroche
If you’re flying within the Schengen area, consider LFPM/Paris Villaroche. It’s southeast of the city and offers handling by Elyxan. There are no customs, and the 37-tonne operating weight so it’s not suitable for all flights. But depending on your route and aircraft, it could be a good alternative to LFPB.
Have you been to LFPB recently? Let us know how it went
A few lines about your visit will help the next crew. Send us an Airport Spy report and let us know what you saw – parking, fuel, handling, customs, any new procedures etc. Anything you wish you’d known prior to your arrival is useful.
Winter Ops: The Stuff You Don’t Want to Forget
Andy Spencer
17 November, 2026
Quick Summary
A look at some things to consider before, during and after a winter flight.
From weather and airport conditions to runway performance, cold-temp corrections, de-icing, taxiing, in-flight icing and fuel, and prepping the aircraft for a cold night.
I’m based in Asia, where 25°C can be considered cold. But thanks to the rather impressive range of a Gulfstream, I still spend much of the year chasing winter around the Northern Hemisphere, from freezing fog in Europe to blizzards on the US East Coast.
There’s a lot more to winter ops than getting the de-icing truck out. With winter approaching in the Northern Hemisphere, here are some of the things I check before heading somewhere properly cold.
1. Before departure
Start with the weather, but look beyond the TAF
I always start with the weather, but the METAR and TAF are only the beginning. Looking at longer-range forecasts from the local met service gives you a much better picture. Then comes the bigger question: what is the airport actually doing about the weather, and can it continue operating when conditions deteriorate?
Some airports are great at clearing snow and treating runways. Others might have a single snowplough and a fairly optimistic approach to winter operations. I always get a kick out of Finavia’s annual winter operations video, Snowhow. But I can’t think of a better name for the expertise needed to keep an airport operating through a proper winter.
Have a chat with your handler about the airport’s winter operations plan, particularly whether the ramp where you intend to park is actually cleared of snow.
Check the SNOWTAMs and any restrictions affecting runways, taxiways and parking areas. If it’s somewhere you haven’t been before, find out how quickly they can clear the runways, what de-icing facilities are available, and what happens when the snow really starts coming down.
It’s also worth checking whether the airport operates with reduced runway widths during snow-clearing operations. A runway might technically be open, but that doesn’t necessarily mean its full width is available. Remember that heavy snowfall can impact operations for many days, so whilst you might be spared the actual storm, how efficiently the airport clears the snow will have a big impact on your trip.
One thing that can get overlooked is your alternate. If your destination and alternate are both under the same weather system, there’s a fair chance they’ll both go downhill together. I prefer to have an alternate well clear of the worst weather, even if it means carrying a bit more fuel.
Finally, ask around. Check with friends and colleagues who have been to the airport or region before. Book knowledge is important, but local knowledge can be far more valuable. OPSGROUP has plenty of Airport Spy Reports that can give you a better idea of what to expect on the ground.
Get familiar with runway condition codes
If you haven’t spent much time operating on contaminated runways, it’s worth refreshing your knowledge of the ICAO Global Reporting Format (GRF). Runway condition reports use codes from 0 to 6, with 6 representing a dry runway and 0 indicating the poorest reported conditions.
But don’t just look at the code. The type of contamination, its depth, coverage and the actual runway conditions all matter. A runway covered in compacted snow is quite different from one covered in wet ice or slush.
It’s important to remember that runway condition codes aren’t a guarantee of braking performance. They’re an assessment of the runway, and conditions can change quickly. Braking action may be reported on the ATIS or passed by the tower, sometimes based on pilot reports. If the braking you experience is different from what was reported, let ATC know.
Check which way round the runway thirds are being reported. SNOWTAMs present them from the lower runway designator – a report given for the direction of use (e.g. on the ATIS) may read the other way round. It’s an easy detail to miss when you’re busy.
Run the numbers for a worse runway
Whenever we’re dispatching to an area with bad weather, we look at the worst-case scenario. What happens if the weather isn’t what was forecast? How bad can it get before we can no longer land there?
I like to run the landing numbers for the worst conditions I expect before we depart. That way, if the weather starts going downhill en route, we already know where we stand.

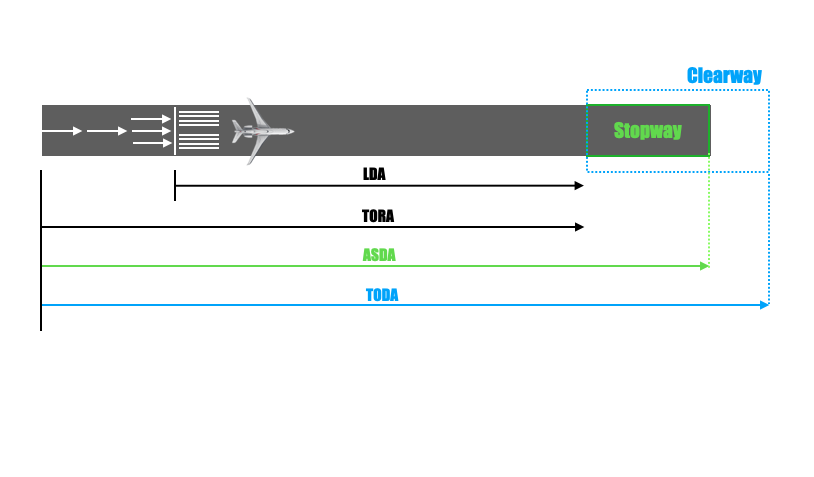

If the destination is reporting a runway condition code of 5, what happens if it drops to 3? Can we still land at our planned weight? What about the crosswind, and do we still have enough runway?
On many jets, reverse thrust isn’t credited in the normal dry-runway landing distance calculations, but it can become an important part of the contaminated-runway performance calculation. This can catch people out when dispatching with an MEL affecting the thrust reversers.
Remember that winter weather can change quickly, and having a few performance scenarios already calculated makes life much easier.
Contaminated runways affect more than just landing distance. Takeoff performance, accelerate-stop distance, crosswind limits and the aircraft’s ability to manoeuvre on the ground may all be affected. Have you briefed what happens if you encounter a slippery taxiway?
On an icy taxiway, even a heavy aircraft can lose traction. Once it starts sliding, the crew may have very little control over where it stops. Think about that before committing to a turn.
One really important thing to remember: check the limitations and performance data for your particular aircraft. Don’t assume the same rules apply to every type. You might see other aircraft getting ready to depart, but that doesn’t necessarily mean it’s OK for you to follow.
Many years ago in Incheon, I was sitting in my Airbus getting de-iced while other cargo aircraft were taking off. I started to wonder if I had made the right decision. Shortly afterwards, a FedEx aircraft taxied into the bay next to me, and I was glad to see him.
Cold-temperature altitude corrections
This is one of those things that’s easy to forget if you spend most of your time operating somewhere warm.
When the temperature drops well below standard, your actual altitude can be lower than the altitude indicated on your altimeter. Back when I first moved from GA onto the Airbus, an older (and wiser) line training captain told me to remember “from hot to cold, look out below.” And that has stuck with me ever since.
The colder it gets, the bigger the error can be, especially on approaches where terrain clearance is already tight.
Some aircraft can make the corrections through the FMS, while others need you to do them manually. Just because your FMS has the capability doesn’t mean you can use it everywhere. Different countries have different rules, and you need to know what ATC expects you to do.
In the US, the FAA publishes specific cold-temperature airport procedures. Other countries have their own requirements, and some approach charts include temperature limitations or correction requirements.
Make sure you know which altitudes need correcting, whether ATC needs to be told, and exactly what your FMS is doing when you select “Cold” mode. Be careful with ATC-assigned altitudes too. Don’t start applying corrections yourself without checking the local procedures and understanding what ATC expects.
This is something we always review as a crew before starting our descent. Leave it until you’re approaching the initial approach fix, and you can end up with a lot of unnecessary confusion in the cockpit.
Time to dig out the cold-weather procedures
Most aircraft have a cold-weather section tucked away in the operating manual, often with a separate de-icing and anti-icing supplement. They’re worth digging out before you head somewhere properly cold. Your next layover at a tropical resort is probably a good time to start.
Before the trip, have a chat with your engineer about cold-soak limits, start-up requirements and how best to protect the aircraft overnight. We’ll come back to this after landing, because that’s when you’ll need to put the plan into action!
De-icing: Know what you’re getting sprayed with
De-icing and anti-icing are two different things. And while it sounds pretty straightforward, it isn’t.
Be well prepared and remember how catastrophic the consequences can be if you get it wrong. This is one part of winter ops that deserves your full attention.
De-icing is about removing the snow, frost and ice already on the aircraft – usually with a heated mix of water and de-icing fluid. Once the aircraft is clean, a second application of anti-icing fluid may be needed to stop ice forming again while you’re waiting to depart.
Depending on the weather and what equipment the airport has available, this can be done in one step or two.
Don’t assume every airport has Type IV fluid. Find out what’s available before you arrive, including the brand and concentrations they offer. Not every fluid or application method is suitable for your aircraft, so get your handler to confirm exactly what they’ll be using.
Then make sure it’s approved for your aircraft and that the ground crew understands any aircraft-specific restrictions. Things like APU inlets and pack air intakes vary between aircraft. Don’t assume the guy in the de-icing truck knows which areas to avoid on yours.
Also don’t assume that because an airport has a de-icing truck, it can properly de-ice your particular aircraft. This is particularly worth checking if you’re flying a large business jet into an airport that normally handles smaller jets.
And remember the clean aircraft concept. Critical surfaces must be free of contamination before takeoff. Crew must also complete the required pre-takeoff contamination checks. Depending on the aircraft and conditions, this may involve inspections that can’t be completed adequately from the cockpit. On ours, we can see the wing clearly from the cabin windows. The tail? That’s another story.
Personally I also think it’s a good idea to brief the passengers about the de-icing process. They have a better view of parts of the wings from the cabin windows than we do from the flight deck, so a short explanation of what’s happening outside can provide some peace of mind.
Holdover times: The clock is ticking
This is the point in the flight where all your preflight prep starts to pay off. Holdover times (HOT) depend on the type and concentration of fluid used, outside air temperature and prevailing weather conditions. There will be times when the forecast makes it pretty clear that de-icing won’t give you a workable departure window. Better to recognise that before you start spraying.
On 25 January 2026, Challenger 650 N10KJ crashed just after becoming airborne from Bangor, Maine, during snowfall. It overturned and caught fire, killing all six people aboard. The aircraft had stopped to refuel on its way to France and received Type I de-icing followed by Type IV anti-icing.
The NTSB’s preliminary report highlights a possible holdover-time issue: about 17 minutes elapsed between the start of anti-icing and takeoff, while the guidance cited in the report gave a maximum of nine minutes for the conditions. It’s an important finding, but we still don’t know what caused the accident. The investigation is ongoing.
This past winter, I spent nearly USD 10,000 on a two-step de-icing in Switzerland for the G700. It’s not cheap, and once you’ve been sprayed, the clock is ticking.
Just remember, being within your HOT doesn’t guarantee the aircraft is still free of ice. The clock starts when the final fluid application begins, not when the truck finishes or you start taxiing. For a one-step treatment, that’s when they first start spraying. For a two-step treatment, it’s when they start the second application.
And be careful with the type of precipitation. Snow, freezing drizzle, ice pellets and freezing rain all have different implications for your HOT, and some conditions may leave you with no usable holdover time at all.
Some conditions have very limited or no published holdover-time guidance. Make sure you’re using the current tables for the fluid actually applied. Both the FAA and Transport Canada publish extensive holdover-time guidance, updated for each winter season.
One thing that caught me out when I moved from the Airbus to the Gulfstream was how wing anti-ice interacts with de-icing fluid. On some aircraft, heating the leading edges can affect the fluid, so there are limits on how long you can have wing anti-ice running after being sprayed. At the same time, the aircraft may require wing anti-ice to be operating before takeoff.
I remember a winter departure from Beijing in an Airbus when we de-iced twice and ran out of HOT both times during the long taxi. Many airports that deal with serious winters, the ones with plenty of Snowhow, have de-icing pads close to the runway threshold. That way, once you leave the pad, you’re not far from taking off.
A shorter taxi can make a big difference to your HOT. De-icing fluid is also a big part of the bill, so there can be a temptation to use a more diluted mixture. Make sure the fluid and concentration are approved for your aircraft and the conditions. At some airports, an “iceman” coordinates the de-icing operation and can tell you what fluid and mixture they’re using. If you need something different, ask before they start spraying.
HOT is used to determine when additional contamination checks or treatment may be required. It isn’t an absolute deadline that guarantees a clean aircraft until the timer reaches zero, nor does exceeding it automatically mean you must de-ice again.
If your HOT expires, the weather changes or you’re unsure whether the aircraft is still clean, follow your company’s procedures. A qualified person, usually a pilot or engineer, may be able to carry out a pre-takeoff contamination check and allow you to depart, provided your procedures permit it. Otherwise, it’s back for another spray. A glance out of the cockpit window is not enough.
Think about the taxi before you leave the stand
You may have noticed that airports which deal with a lot of snow often have orange markings and elevated edge lights mounted on posts.
There’s a good reason for this. Snow-covered movement areas can be surprisingly difficult to navigate. Normal taxiway markings can disappear under the snow, signs become harder to spot, and what looks like a clear taxiway could be covered in ice.
Braking and steering can be significantly reduced, particularly when turning. So it is worth checking whether there are restrictions on taxi routes, reduced taxiway widths or areas that haven’t been cleared. Also remember that heavily used areas, particularly rapid exit taxiways, can become extremely slippery as aircraft track snow and slush onto cold surfaces, which can then freeze.
Airports may issue Notams or other local warnings when taxiway conditions become particularly challenging, so make sure you check what’s being reported. When operating in snow, give yourself plenty of space, keep taxi speeds sensible, and be careful with engine thrust around loose snow and ice.
You also need to consider whether your aircraft requires engine ice-shedding procedures before departure. Ice can accumulate inside engines during ground operations, particularly in freezing fog or other conditions where moisture is present.
We’ve all read the procedure and probably done it in the sim, but have we actually thought about how we’re going to carry it out when we’re sitting in the queue for the de-icing pad with three aircraft behind us? Depending on the aircraft, ice shedding may require increased engine thrust for a specified period. That’s not something you want to try for the first time on a slippery taxiway with other aircraft close behind.
Work out where you can safely do the ice-shedding procedure, whether ATC needs to be involved, and when you plan to do it. Better to sort this out in the briefing than when you’ve got a queue of aircraft waiting behind you.
2. During flight: Keep reassessing
In-flight icing isn’t always obvious
Most modern business jets have good ice protection systems, but that doesn’t mean icing conditions can be ignored. Make sure you’re familiar with the conditions that require ice protection, along with any limitations on using those systems. Our G700 prohibits wing anti-ice above FL450. I’m not sure I’d expect icing up there, but it’s food for thought.
Ice can build up in places you can’t see from the cockpit. Keep an eye on the TAT/SAT and know when your aircraft requires ice protection to be switched on.
Don’t wait for the ice detector to tell you that you’re in icing conditions. Some engines can also experience vibration as ice builds up and sheds from the fan blades. This may be an expected characteristic or something requiring further action. Some engines perform ice shedding automatically through the FADEC, others require pilot intervention.
But even the most advanced aircraft have limits to what their ice protection systems can handle. If you encounter icing conditions beyond the aircraft’s capabilities, exercise good airmanship and get out of those conditions.
Keep an eye on fuel temps
When flying in cold weather, fuel temperature is another consideration, particularly on long flights in very cold conditions. Different fuel grades have different freezing characteristics, and aircraft have specific minimum fuel-temperature limitations.
Keep this in mind if you’re departing somewhere warm but flying somewhere cold, especially if you’ve uplifted a different fuel grade.
If fuel temperature is approaching a limitation, act early. Descending into warmer air may help. On some aircraft, flying faster can help warm the fuel through aerodynamic heating, although how much it helps varies. Don’t wait until you’re approaching the fuel temperature limit to figure out what you’re going to do.
Don’t leave the landing performance until final
A lot can change during a long flight. When I fly the G700 from Asia to the USA, we often depart just as the destination TAF is beginning its validity period. During our initial planning, the destination might be reporting good braking conditions, but 14 hours later the runway could be covered in snow.
Make a point of regularly checking the latest weather, runway condition reports and Notams. These days, with all the Wi-Fi connectivity available onboard, it’s become easier to update this information throughout the flight. And if the runway condition code has deteriorated, rerun your landing performance.
We often take the performance of our business jets for granted, but it can catch you out. Get into the habit of completing a landing distance assessment (LDTA), particularly if ATC changes your landing runway.
The wind might have shifted too, leaving you with a tailwind or crosswind you hadn’t planned for. A contaminated runway, strong crosswind and poor visibility aren’t exactly how you want to finish a long day.
If the numbers no longer work, or you’re simply not comfortable with the conditions – divert. I’ve always believed it’s better to explain a diversion to the boss than explain why we pressed on when we shouldn’t have.
The approach can look very different in winter
We fly into RJCC/Chitose in both summer and winter, and it’s amazing how much snow changes the look of an airport. Runway markings become difficult to see, taxiways blend into the surrounding snow, and the usual visual references aren’t always obvious.
Add poor visibility or blowing snow, and judging your height and distance visually can become quite difficult.
In these conditions, stick with the instrument approach, make any required cold-temp corrections and use the flight director rather than switching to visual references too early.
Be especially careful at unfamiliar airports surrounded by snow-covered terrain. When everything outside is white, it doesn’t take much to lose your visual references altogether.
3. After landing: The job isn’t over yet!
Watch out on the taxi in
Getting the aircraft onto the runway is one thing, but don’t assume the taxiways and parking areas are in the same condition. They can be a lot more slippery than the runway, particularly if they haven’t been cleared or treated as often. Keep in close communication with your handler or FBO to make sure your planned parking area is suitable.
Keep taxi speeds down, allow plenty of room for turns and be particularly careful when approaching the stand. Aircraft tyres can slip even at 5 knots, so take it slowly. Ground staff may also have difficulty moving around on icy surfaces, so give them time and space. The same applies to you when doing the walkaround.
Snow and ice can hide markings, drains, equipment and other obstacles around the parking area. Snow also reflects a lot of light, so sometimes turning on your taxi lights can actually make it harder to see.
We were in Washington last year and ended up having the FBO staff walk us out to the main taxiway because the snow piles were so high. Don’t be afraid to ask for help!
Watch those brakes
Brakes can be another problem after taxiing through snow, slush and freezing conditions. Even with modern carbon brakes, moisture can freeze around the brake components once you’ve parked. Many aircraft have specific procedures for brake temperatures, cooling and parking brake use in cold weather.
On some aircraft, leaving the parking brake set in freezing conditions can cause problems when you come back to depart. Make sure you know your aircraft’s procedures and that the ground crew understands what you need them to do once you’ve parked.
This is especially important when chocking the aircraft on a slippery apron. I won’t release the parking brake until I’m satisfied the aircraft is properly secured. For me, that means being triple-chocked. If the ground crew hasn’t brought enough chocks, I’ll ask them to get more.
Protect the aircraft before you leave
If the aircraft is going to sit outside overnight, there’s quite a bit to think about.
Do you need engine and APU covers? What about the pitot probes, static ports and other exposed equipment? Make sure you’ve got a plan to protect them if it snows while the aircraft is parked.
Do batteries or other equipment need special attention in extreme temperatures?
Will the aircraft need external heating or ground power before the next departure? How will you make sure the engines are free of ice? You may need to arrange ground heating, and at some airports the equipment needs to be booked in advance.
What happens if there’s heavy snowfall overnight? A prolonged cold soak can affect batteries, tyre pressures, hydraulics, engine oil and fuel temperature. Check your aircraft’s cold-weather limits and whether you’ll need preheating or any special procedures to get things running again. Some equipment may also need to be removed or protected before you leave.
This is where a good local handler and engineer are worth their weight in gold. They’ll know what to expect overnight, what facilities are available and whether there’s somewhere nearby you can reposition to get the aircraft into a hangar.
If hangarage is available, it’s worth considering, especially if you’re expecting heavy snow or several days of extreme cold. Humans generally don’t like extreme cold, and neither do aeroplanes.
Don’t forget the water and lav systems
This is an easy one to overlook. We generally land with water still in the aircraft’s system, and that can become a problem pretty quickly when temperatures drop below freezing.
Depending on the aircraft, you may need to drain or purge the system, or keep it heated above a specified temperature. Have you worked out how you’re going to do that at your destination?
For us, we always purge the system before leaving the aircraft in freezing conditions.
Don’t forget the waste tanks and lavatory system either. Every aircraft has its own requirements, so check the manual and have a chat with your engineer before leaving the aircraft out in the cold.
It’s much easier to deal with these things on arrival than when you’re preparing for a twelve-hour flight the following morning. A frozen water system can leave you with a grounded aircraft and a substantial repair bill. That’ll give the boss a frosty attitude too.
A trap when heating the aircraft
Heating an aircraft on the ground sounds simple enough, but if the doors are closed and the air has nowhere to escape, you can end up with a pressure difference between the cabin and outside.
On 4 January 2018, the captain of a Gulfstream G150 was killed at Kittilä, Finland, when the cabin door opened violently under pressure as he tried to open it from outside.
The APU was supplying bleed air to heat the cabin. The captain had gone outside to help remove snow and closed the door, leaving the cabin attendant inside. With the outflow valve closed, pressure built in the cabin. The attendant felt pressure in her ears and chest and knocked on a cockpit window to attract the pilots’ attention. When the captain tried to open the door, it struck him, causing fatal injuries.
It’s a grim reminder of what can go wrong. Know the procedures for ground heating, checking cabin differential pressure and opening doors. If anyone inside starts feeling pressure in their ears, take it as a warning and remove the bleed air. Before opening the door, make sure the outflow valve is open and the cabin is fully depressurised, following your aircraft’s procedures.
And look after yourself
Finally, don’t forget the crew! Spending half an hour outside doing a preflight in minus 20 isn’t much fun, particularly when there’s wind and blowing snow. Tempting to give that sector to the first officer, but whoever does it needs to be properly dressed.
It’s harder to concentrate and work with your hands when you’re freezing cold, and icy ramps are an easy place to come unstuck. Make sure you’ve packed a proper winter jacket, gloves and shoes with decent grip!
2027: What’s changing on the North Atlantic?
David Mumford
17 November, 2026
We recently went to the NAT Ops Forum in Montreal to find out what might be changing on the North Atlantic.
There’s still no news on when Shanwick will remove oceanic clearances. But we came back with notes on a few other things worth knowing:
RCLs and procedures across the five OCAs
Gander’s post-OCR lessons
Mixed whole and half-degree tracks
FF-ICE implementation
Malbusca (Azores) and the SpaceX (US) launch impact on the NAT
TTA – target time of arrival
GPS jamming and spoofing on the NAT
Greenland as an option for tech stops and diversions
A cheeky little operator wishlist
An upcoming datalink NAT Ops Bulletin update
Space-based VHF, supersonic ops and the next NAT Doc 007
OPSGROUP Members
Read the full NAT Briefing in your members dashboard. Further updates and member feedback will be posted here.

APEC 2026: Business Aviation restrictions around Shenzhen
David Mumford
17 November, 2026
Quick Summary
The 2026 APEC conference is happening in Shenzhen from Nov 18-19, but flight restrictions run from Nov 11-22. Non-participating business jets are restricted from airports in the region.
Affected airports: ZGSZ/Shenzhen, ZGGG/Guangzhou, ZGSD/Zhuhai, ZGHZ/Huizhou and VMMC/Macau.
No official restrictions announced at VHHH/Hong Kong so far
If you’re APEC-related
Your options should be better, but check with your handler before planning a flight. We understand the restrictions are aimed at non-participating flights, but even if you’re taking in APEC pax your approvals for parking etc still need to be confirmed.
If you’re not APEC-related
Bad news, you’ll most likely need to avoid airports in the affected area.
ZGZU/Guangzhou ACC Notam A5871/26 sets up a 200km restricted area around Shenzhen and prohibits general aviation flights without prior approval – and reports suggest it’s proving impossible to obtain this if you’re not doing an APEC-related flight. And this Notam only dropped yesterday, Nov 10, so keep in touch with your handler as things are likely to change further!
China and Macau: This includes ZGSZ/Shenzhen, ZGGG/Guangzhou, ZGSD/Zhuhai, ZGHZ/Huizhou and VMMC/Macau airports.
Hong Kong: Member reports say VHHH/Hong Kong remains open but you must have slots/parking/ppr confirmed. Local agents also reportedly advised that flights between Hong Kong and the Guangzhou FIR are not allowed in either direction. We haven’t found any matching Hong Kong Notams or official statements on this yet, but we’ve had a couple of OPSGROUP member reports saying that their permits overflying Guangzhou FIR revoked – so confirm the latest update with your handler before operating!
For parking elsewhere: The nearest international airports outside the 200km zone are ZGNN/Nanning, ZGKL/Guilin, and ZGOW/Shantou. If you don’t fancy the sound of that, maybe have a look at the likes of VVDN/Da Nang, RPLC/Clark or VTBD/Bangkok. But of course these airports may fill up as operators move aircraft out of the region.
Bottom line: If you’re carrying APEC pax, confirm your approvals and airport access with your handler. If you’re not, plan to park outside the affected area and keep checking for updates!
OPSGROUP member reports: If you know different to any of the above, or have an update to share – please do! We can use it to update this briefing and let everyone else know. Email: team@ops.group
Top Tips on China Ops
Andy Spencer
17 November, 2026
Quick Summary
An updated guide to operating business aircraft into China, with a few lessons learned from 20 years flying around Asia.
All the most important things to know: importance of using a decent local handler, airports open to foreign business aviation, permits, route restrictions, metric flight levels, radio comms, parking limits, customs, catering, crew visas, GPS interference, in-flight connectivity, Alipay and WeChat.
I’ve been based in Asia for the past 20 years and regularly fly into China. It’s a great place to fly, but it can also be one of the more challenging countries to operate into, particularly if you’re not familiar with the region.
My biggest advice? Be prepared, use standard ICAO English, be flexible, have a trusted ground handler and above all, be patient.
China is busy, really busy, just like the US and Europe, there is a huge domestic and international airline flights. Where it differs is how much restricted airspace there is (hint: a lot). And to compound things, there are some fairly restrictive rules about where foreign aircraft can fly. When you add permits, parking, customs and the occasional last-minute restriction, it is a lot to think about. Here are my top tips…
Get yourself a good handler.
I’m putting this first because, in my experience, it’s probably the single most important thing you can do. Good handling won’t be cheap, but trust me, you want good. Having a good handler who knows the local authorities, understands the airport restrictions and can get answers when things change is the best thing you can do to ensure a successful trip.
If it’s your first trip to China, ask other crews who fly here regularly for recommendations. There are plenty of options, and some trip support companies also have local agents who work directly with the airport handlers.
To give you some perspective on what a great handler looks like, I have a support team in a WeChat group. Day or night, I can drop a message and almost immediately have somebody helping me. I cannot stress enough how valuable that is when operating in China.
When I think back to my first trip to Shanghai and compare it to my last one just two weeks ago, I’m amazed at how much things have changed, and for the better. But be mindful that changes can happen overnight, so having a good local contact is a must.
Recently, we’ve seen business aviation restrictions introduced at Beijing and Xiamen with little warning, with significant operational impacts lasting days or even weeks. An airport that was perfectly accessible when you started planning might not be available when you’re ready to depart.
My trusted handler is Yini Lin at Affinity Aviation, which recently rebranded from Universal Aviation. I’ve worked with Yini on my own flights into China, and she’s the person I have on speed dial when I need something sorted. (Don’t let the name change fool you. It’s still the same ground handling business, with the same teams and, most importantly in China, the same relationships.)
Not every airport is open to foreign business aviation
This has caught me out before. You get told the boss wants to visit a golf resort somewhere in China. There’s an airport nearby with a big runway, so naturally, the assumption is that you can fly them there.
Unfortunately, it’s not that simple. China only opens certain airports to foreign business aviation. Whilst we can call it a “list”, it’s not quite that clear-cut. If your destination isn’t on it, things become considerably more complicated.
You’ll need a government sponsor letter and a CAAC navigator onboard. The navigator brings the local airport charts, which won’t be available in your usual charting system (Jeppesen/Lido), and handles communications with ATC. They must be part of your crew.
Getting a permit for an airport that’s not on the list is difficult. Without the right local government support, it may simply not be possible. Even with a local sponsor, give yourself plenty of time, generally three weeks or more.
Things are easier when operating into an ‘open’ airport, but just because foreign aircraft can apply for permits doesn’t mean access is guaranteed. Parking restrictions, military activity, major events and short-notice government requirements can all affect your plans.
My best advice is to stay in close contact with your handler before getting too far into the planning phase. They’ll be able to keep you informed when something changes.
The following list was provided by my handler and was current as of October 2026.
Airports open to foreign business aviation:
ICAO
Airport
ICAO
Airport
ZBAA
Beijing Capital
ZBAD
Beijing Daxing
ZBTJ
Tianjin Binhai
ZBSJ
Shijiazhuang Zhengding
ZBYN
Taiyuan Wusu
ZBHH
Hohhot Baita
ZBLA
Hailar Dongshan
ZBOW
Baotou Donghe
ZYTX
Shenyang Taoxian
ZYTL
Dalian Zhoushuizi
ZYCC
Changchun Longjia
ZYYJ
Yanji Chaoyangchuan*
ZYHB
Harbin Taiping
ZSPD
Shanghai Pudong
ZSSS
Shanghai Hongqiao
ZSNJ
Nanjing Lukou
ZSWX
Wuxi Shuofang
ZSCG
Changzhou Benniu
ZSXZ
Xuzhou Guanyin
ZSYN
Yancheng Nanyang*
ZSLG
Lianyungang Baitabu
ZSHC
Hangzhou Xiaoshan
ZSNB
Ningbo Lishe
ZSWZ
Wenzhou Longwan
ZSZS
Zhoushan Putuoshan
ZSOF
Hefei Xinqiao
ZSTX
Huangshan Tunxi
ZSFZ
Fuzhou Changle
ZSAM
Xiamen Gaoqi
ZSQZ
Quanzhou Jinjiang
ZSCN
Nanchang Changbei
ZSJN
Jinan Yaoqiang
ZSQD
Qingdao Jiaodong
ZSYT
Yantai Penglai
ZSWH
Weihai Dashuibo*
ZHCC
Zhengzhou Xinzheng
ZHHH
Wuhan Tianhe
ZGHA
Changsha Huanghua
ZGDY
Zhangjiajie Hehua
ZGGG
Guangzhou Baiyun
ZGSZ
Shenzhen Bao’an
ZGOW
Jieyang Chaoshan
ZGNN
Nanning Wuxu
ZGKL
Guilin Liangjiang
ZJHK
Haikou Meilan
ZJSY
Sanya Phoenix
ZUCK
Chongqing Jiangbei
ZUUU
Chengdu Shuangliu
ZUTF
Chengdu Tianfu
ZUGY
Guiyang Longdongbao
ZPPP
Kunming Changshui
ZPLJ
Lijiang Sanyi
ZPJH
Xishuangbanna Gasa
ZLXY
Xi’an Xianyang
ZLLL
Lanzhou Zhongchuan
ZLDH
Dunhuang Mogao
ZLXN
Xining Caojiabao
ZLIC
Yinchuan Hedong
ZWWW
Urumqi Diwopu
ZWSH
Kashgar Laining
ZYYJ, ZSYN and ZSWH are listed as open only to Korean-registered aircraft.
Please don’t use this list as a reference, it is just a guide to show you which are currently open airports. Airport restrictions can change overnight so please check with your handler before committing to a trip.
Permits: Don’t wait, get started early
There are two types of permits you’ll need to consider when operating in China:
Landing Permit
Overflight Permit
And this is generally where things start to get a little more complicated.
Back in March 2025, the CAAC (Civil Aviation Administration of China) introduced additional documentation requirements through what it calls the “Preflight Permit Application System”. You have to provide your aircraft registration certificate, certificate of airworthiness, radio licence, insurance, noise certificate, cabin layout and an authorisation letter.
The good news is that these docs can be kept on file, so the most painful part is usually the first application. If have not done this before, then your handler will need to complete that process at least five working days before submitting a landing permit application.
If you think you might come to China one day then this is something you can do in advance – just because you’ve got nothing on the schedule doesn’t mean you can’t get the paperwork ready.
There was another change on April 1, 2026 (and no, sadly it wasn’t an April Fools’ joke). All ATC charges must now be prepaid, or covered by a registered Letter of Guarantee (LOG), before CAAC will accept a landing or overflight permit application. This includes enroute and approach control charges.
The LOG isn’t really an option for most operators, so letting your handler be the middle man will make your life much simpler.
You should also try to avoid unnecessary last-minute changes to your routing or schedule. China isn’t particularly forgiving when permits need repeated revisions, and too many changes can put your approval at risk.
Don’t expect your requested flight level
This is probably one of the biggest differences you’ll notice when flying in China.
There is a LOT of traffic, and a LOT of restricted airspace.
Next time you’re there, turn on the airspace display on ForeFlight or your ND. It will help explain why the airways go where they do. Foreign operators are restricted to certain routes, so you won’t always be able to fly the most direct route or at the level you’d normally expect.
When flying domestically, I generally plan to be somewhere in the high FL200s or low FL300s. If I’m transiting Chinese airspace on my way to or from Europe, I might get as high as FL411, although FL391 is often more realistic.
And when ATC keeps you low, repeatedly asking for higher generally isn’t going to help.
It’s really important to plan your fuel around these constraints. Do your planning on the assumption that you’ll be kept low. If you manage to get your optimum level shortly after departure, I’ll buy you a gin and tonic. Sadly, this generally doesn’t happen, and if you plan for a level you’re unlikely to get, you’re going to get caught out.
It’s not unusual to remain lower for a considerable portion of the flight, and reroutes are always a possibility.
Don’t expect too many direct-to clearances either. The route structure is heavily influenced by military airspace, and ATC often has very little flexibility. If you need weather deviations, I’ve found that requesting a heading is more likely to be approved than a track offset. If neither works and you genuinely cannot avoid hazardous weather, don’t hesitate to declare PAN PAN if the situation warrants it.
I do a lot of long-haul flying out of the region, and while I have no issue planning Hong Kong or Macau to the US East Coast, I don’t plan the same flight nonstop out of China. We normally stop in Nagoya to pick up fuel before continuing to the US.
While we’re talking about fuel, it’s worth knowing that at many airports, fuel uplift is restricted to departure because of the local customs process. So don’t plan on refuelling on arrival without checking first.
The good news is that fuel in China can be relatively inexpensive. I’ve recently seen prices around US$4-5 per US gallon, although this varies by airport and supplier.
We always tanker fuel out of China because the price and aircraft performance make sense to our operation, but make sure you understand the local fuelling arrangements first.
Remember the metric flight levels
China uses metric cruising levels. Your aircraft and crew need to be set up for this, and you should be familiar with the metric-to-feet conversion procedures before entering Chinese airspace. You’ll notice that assigned flight levels don’t correspond to the usual ICAO levels. Think FL271, FL391, etc.
Use the published Flight Level Allocation Scheme (FLAS) conversion table and your approved aircraft procedures. Don’t try to calculate the conversions on the fly.
Metric levels are assigned by ATC in China. In my experience, when entering Chinese airspace, ATC will generally move you to the nearest metric cruising level. This is often only 100-200 feet from your previous level. When leaving China, you can expect a new clearance around 20 NM before leaving Chinese airspace.
Something that caught me off guard during my early years flying in China was the altimeter setting phraseology. ATC will clear you to climb or descend “on standard” – meaning you’re flying a flight level. If they clear you to climb or descend “on QNH” – you’re flying an altitude using the local QNH.
For years, I thought they were saying “non-standard”.
Finally, it’s very common to be asked to descend at 2,000 fpm or greater due to overlying airspace restrictions. If you work with ATC and help them out, you’ll generally find they’re very accommodating.
Keep your radio work simple
There are a lot of frequency changes in China, and sometimes they come fairly quickly. Pay attention and make sure you’ve copied the next frequency correctly.
The use ofstandard ICAO English is a must. Speak clearly, keep it simple and avoid conversation. ATC generally works well, but English proficiency varies sector to sector. Standard phraseology makes everybody’s life easier.
It is becoming more common for the bigger airports to have D-ATIS and PDC. However enroute datalink is a different story – CPDLC isn’t available across most Chinese airspace. Limited services exist on the L888 and Y1 routes, but these routes require special approvals and aren’t generally available to business aviation operators.
Keep a listening watch on 121.5 MHz as well. If you miss a frequency change, you may receive a call asking you to contact ATC. CAAC takes communication failures seriously, and if you do loose comms during your flight, even for a short while, it’s probably that you will get a RAMP check on arrival. I always use my Bose headsets rather than relying on the cockpit speaker when operating in China.
Parking can be the hardest part
Getting a landing permit doesn’t necessarily mean you’ll get the parking you want.
China’s two biggest aviation hubs, Beijing and Shanghai, are great examples of where business aviation parking can be limited and restrictions can change at short notice. Sometimes you won’t receive final parking confirmation until quite close to arrival. At other times, you may need to reposition the aircraft after dropping off passengers.
If you need to go into Beijing, ZBAA/Capital generally limits business aviation parking to 24 hours and requires a local invitation letter. ZBAD/Daxing and ZBTJ/Tianjin can be useful alternatives, as they don’t normally require special approvals and long-term parking is generally available.
Shanghai has similar challenges, with ZSSS/Hongqiao and ZSPD/Pudong having different operating and parking limitations. Don’t assume an airport that worked for your last trip will work the same way next time.
At some airports, hangar space is available and may help secure your parking. Whenever we operate into ZSSS/Hongqiao, we arrange a hangar, which allows us to get parking confirmed much earlier.
One final point about parking: at many Chinese airports, GA aircraft, including large-cabin Gulfstreams, are required to be tied down to the apron.
Yes, just like we used to do with our Cessnas.
The ground handler will arrange the straps, but I’d recommend checking with your engineer how they should be fitted to your aircraft. Typically, one strap is provided for each wheel, secured to two tie-down points on the apron. Most larger airports have an MRO presence, so getting an engineer or mechanic to help generally isn’t too difficult. Just plan ahead.
During typhoon season (May-October), airports may require aircraft to be moved if there’s a typhoon threat. Depending on the storm’s track, Japan or Korea may be practical relocation options. Otherwise, check whether a local hangar is available.
Customs will inspect everything
Be prepared for very thorough customs inspections on both arrival and departure. In my experience, every drawer, cupboard and door on the aircraft will be opened and checked. Be patient. It’s their process, and getting frustrated won’t make it go any faster. They also tend to carry body cameras, so make sure you smile!
Keep the cabin organised, have your paperwork ready and allow plenty of time for the inspection. I usually allow around 30 minutes for customs on both arrival and departure.
It’s also normal for your passport to be taken away during the customs and immigration process. Don’t be alarmed, you’ll get it back before leaving the airport.
One final tip for crews: once you’ve cleared customs and left the airport, you generally won’t be able to return to the aircraft until departure. If you need to update navigation databases, complete a fuel sump check or carry out any other work onboard, make sure it’s done before leaving the airport. Otherwise, plan to arrive earlier on departure day. Customs will normally allow crews airside access within three hours of ETD.
Getting back to the aircraft during your layover is generally not possible, so plan accordingly.
Catering needs some planning
Your cabin crew is going to have a harder time sorting out the catering than you are probably used too. At most airports, security restrictions mean you can’t just carry food through the terminal and take it onboard. Try and arrange catering through your handler, they will then arrange it to get onboard. Often they will be able to recommend local restaurants or hotels that can help you as well.
If you have special catering requirements, or you’re planning to bring food from outside the airport, discuss this before arrival. It’s much easier to sort out in advance than discover on departure day that your catering can’t get through security.
And if you decide to grab a coffee while you’re in the terminal, drink it quickly! Security probably won’t let you take it onboard.
Check everyone’s visa, especially positioning crew
This is something I regularly see catch people out.
Operating crew WILL need a Chinese crew visa (C visa), unless they hold a valid Home Return Permit.
I recommend that any crew coming into China also get a business visa (M visa). Chinese consulates will generally issue both, and having the M visa gives you another option if you unexpectedly need to position into or out of China on an airline.
Remember that China’s visa-free entry arrangements don’t apply to operating crew. Make sure everyone has the correct docs, including cabin crew and engineers.
Getting an engineer to the aircraft if they didn’t arrive with you can be particularly difficult. I always carry mine with me when we’re doing China flights. If you’re planning a crew change, check the requirements with your handler well in advance.
Your handler will usually need to issue supporting letters for crew arriving or departing on an airline flight. I also ask my handler to arrange an escort for positioning crew. It saves a lot of stress at airline check-in and immigration.
GPS interference and Joint Civil/Military Airports
GPS interference has been reported in China. OPSGROUP has received reports of GPS jamming and spoofing around Beijing, including aircraft experiencing navigation position errors, synthetic vision problems and false terrain warnings.
More recently, there have also been reports around ZGGG/Guangzhou and nearby VHHH/Hong Kong.
China has numerous mixed civil/military airports, where restrictions on photography and aircraft movements can be very strict. At some airports, you’ll be instructed to close all cabin window shades during approach, taxi and departure.
Don’t ignore these instructions from your handler. Compliance is checked. You must follow these local instructions, and don’t photograph military aircraft or facilities. Crews have been detained while their phones and cameras were checked, so don’t be that crew.
Starlink won’t work in China
If you have Starlink, you will need a backup plan because it won’t work in Chinese airspace.
The service is geofenced automatically and, in my experience, disconnects as you enter China’s FIR.
Other satellite connectivity systems, including Viasat and Inmarsat’s Ka-band or Ku-band systems, generally continue to work. If your aircraft has a one of these connectivity systems, it is probably wise to make sure you have it working.
Finally be sure to let the passengers know that they are likely to have internet issues during the flight, this will solve any heartache that might come from an unexpected Zoom call dropout.
Alipay and WeChat – get both.
This last one has nothing to do with flying the aircraft, but it might be the most useful tip for your layover.
You really do need Alipay and WeChat in China.
China is practically cashless, and these two apps are used for just about everything. When I say cashless, I really do mean it. I haven’t spent a single RMB note in a decade.
Whilst cash is legally accepted in China, in practice you’ll find very few people want to take it. Save yourself the hassle and get the apps set up before you arrive.
The good news is that foreign visitors can now link international credit cards to both apps. You’ll use them for paying in restaurants and shops, communicating with people locally and booking transport.
For taxis, I would recommend using DiDi which is China’s equivalent of Uber and can be accessed through the apps. I always prefer DiDi over picking up a taxi on the street. You know who’s collecting you, where you’re going and what the trip should cost.
My advice is to install both apps, register your accounts, link your credit cards and make sure everything works before you arrive in China. If you need help, your hotel concierge can usually sort you out, or just ask your handler on arrival, they will be able to get you on track before you leave the airport. Another advantage of these two apps is the translation service, using Didi through Alipay or WeChat will automatically make the app English, and allow you to communicate with your driver as well.
Get these apps up and running before you you’re standing outside a hotel trying to go for dinner.
We also use WeChat to communicate with our local handlers.
Finally, remember that when you connect to local Wi-Fi in China, apps such as WhatsApp and Facebook generally won’t work. If you’re using an international data roaming package, these services will often continue working without a VPN. And speaking of VPNs, don’t assume yours will work. China’s internet restrictions block many of them.
For me, international roaming is generally the easiest option, and it’s how I keep in touch with the rest of the world. Remember that roam e-sims such as Airalo etc, will be the same as using a local SIM card, so it is probable that the Chinese firewall settings will apply.
Final thoughts
China isn’t difficult because of any one particular rule. It’s the combination of restricted airspace, traffic, permits, airport access and procedures that can change with very little notice.
I have spent 20 years based in Asia, and my approach has always been simple. Prepare properly, always carry extra fuel for the levels and routing you’re likely to get, not just the ones you’d like. Be patient with ATC and customs, and make sure the paperwork is right.
Finally and above all, have a good local handler you trust. That’s what makes the difference between a stressful trip and a great experience, both for you and your pax.
Burdensome new Ebola rule will affect every US-bound flight
OPSGROUP Team
17 November, 2026
Quick Summary
From November 4, every passenger person on a flight departing for the US must complete a new Ebola form
Applies to all aircraft operators: airline, charter, non-scheduled, business aviation – everyone
Setting up the process to handle this will be burdensome for many operators
Update: Friday, 30 Oct 0930Z:
CDC have now updated their guidance on the new Ebola form, to be more specific that this applies to everyone on board, including crew. The new language refers to “all people boarding an international flight to the United States”. However, as we predicted last week (the crystal ball works!), airlines are now pushing back strongly on this new rule. IATA and A4A are asking for the rule to be changed, saying that “Changes to check-in systems, digital signatures, station procedures, and training cannot readily be completed in the allotted time,”. Depending on the outcome of this challenge, we may see the rule relaxed, postponed, or … not. We will keep you posted!
Update: Monday, 26 Oct 1320Z:
We have received written confirmation from US CBP, that this does also apply to flight crew. The language in the Order, and the associated documentation, currently refers only to passengers. However, it will apply to every person on board. Updated/corrected guidance from CDC and CBP is expected to follow.
Original Briefing:
From midnight on November 4, every flight departing for the United States will require that passengers have completed a new form, stating that they have not been to the D.R.C./Congo in the past 3 weeks.
For all operators, this presents a rather burdensome paperwork requirement, at very short notice. It applies to every aircraft arriving into the US, not just airlines.
What are the new rules?
Every passengerperson on board an aircraft bound for the US is required to complete the Ebola form before boarding
The form is an attestation that they have not been in the D.R.C. (Democratic Republic of the Congo, Congo-Kinshasa, “the big one”) in the past 3 weeks (21 days)
The aircraft operator must collect the form from each passenger (physically, or via a digital version) and retain it for 6 weeks (42 days)
What operators does this apply to?
This applies to all aircraft operators. Airlines, Charter, Business Aviation, private flights, Cargo (if you have “pax”) – everyone
There are no differences between different operator types. Same form, same requirements
This applies to crew also – confirmed by CDC.
Exemptions
For passengers, basically none. The only mentioned examples in the technical instructions are for flights with Ebola patients, or government flights given permission by the CDC to operate without the form
OPSGROUP View
The new requirement has taken members by surprise, with a short timeframe to implementation
Implementing the form collection and retention process will be burdensome for most operators. Some pushback from airline trade organisations might be likely in the coming week
The official form provides room for the passengers name only, without any mention of flight number, seat, or date of flight. Operators therefore have to find a way to reliably link the signed form to the PNR or passenger details.
Creating an in-house digital process for this seems to be the easiest approach
If you have any tips on implementation to share for the group, please let the OPSGROUP Team know.
Start here – Official Sources
If you are just getting started with implementing the process, the following are the official documents and sources. We have saved copies of the current forms here for members to make things easier, but check for any updates.
If you have any input on how this is affecting your flight operations, please let the team know. We are especially interested in hearing how you are implementing the process, if you are using a digital method, and anything you learn along the way. We will then be able to update members. Thanks!
OPSGROUP Members
Review the full New Ebola Rule Briefing in your members dashboard. Further updates and member feedback will be posted here.
Questions and Answers
Below are some of the member questions we have answered.
Is this just for African countries?
Nope, the place you depart from for the US is not relevant. All flights, all origins.
What happens if the passenger HAS been in the Congo in the last 21 days?
Then CDC says they cannot travel to the US. There is a mandatory 3 week waiting period. CDC says that “You are considered to have been in the DRC if you were physically present in DRC at any time during the previous 21 days. This includes entering or traveling through DRC by air, land, or sea. Connecting through an airport in DRC also counts as being present in the country, even if you did not leave the airport or the plane. The 21-day waiting period is based on calendar days. Day 0 is the day you leave DRC, and Day 1 is the first full calendar day you are outside DRC. You may board a flight to the United States beginning on Day 22, provided you meet all other travel requirements. You will not be allowed to travel to the United States during Days 0–21.”
Could Starlink be the answer to GPS interference?
Chris Shieff
17 November, 2026
Quick Summary
GPS interference is widespread – and actually getting worse.
Hopes kindled: Starlink could potentially help, thanks to their stronger signals which are harder to jam/spoof. 😀
Hopes crushed: Starlink isn’t approved for navigation (yet), and SpaceX disabled access to terminals’ location data. Thanks guys. ☹️
It’s been over two years since OPSGROUP and nearly a thousand industry professionals published a comprehensive report on the problem of GPS spoofing. And more recent data shows this safety risk has continued to escalate.
Earlier this month, IATA shared some worrying numbers. When compared to 2023, 2025’s data showed that spoofing incidents had risen by 193%, along with a 67% increase in jamming.
Recent updates by the team at SkAI also confirm that GPS interference remains rife throughout the usual major hotspots including the Southeastern Med, the Red Sea, Persian Gulf, in and around Russia, the India-Pakistan border and Myanmar.
It seems clear the problem isn’t going away anytime soon. If you get a chance to read the report mentioned above, you’ll begin to get a feeling of just how deeply-embedded GPS actually is in what we do. The problem now is that we are heavily reliant on a system that is known to be easily manipulated or degraded with safety-critical consequences.
And we cannot continue to accept this status quo forever. GPS needs a back-up, and one that works reliably, everywhere. Granted, advances are being made in magnetic navigation which uses sensors to read fluctuations in earth’s magnetic field to fix a position – it’s clever, but also complicated!
There may be a more obvious solution using existing technology staring us right in the face – Starlink. But the problem is that SpaceX recently made changes to prevent this.
All the right signals
Here is the inherent issue with GPS. The satellites orbit high – around 20,000km (12,500 miles) above the ground. By the time their signals arrive here on earth, they are weak. So weak in fact, that low-powered devices on the ground can easily interfere with them.
Starlink on the other hand has thousands of satellites in low-earth orbit at altitudes of only around 550km (340 miles). This presents an opportunity – because the Starlink satellites are so low, their signals are much stronger than conventional GPS.
Starlink terminals themselves are also different to traditional GPS receivers. They consist of a flat panel with an array of small antennas. Together these direct a narrow beam towards orbit, inadvertently helping to phase out sources of interference low on the horizon. If used for navigation, the signals could be much harder to jam or spoof. Not entirely (as recent events in Russia and Ukraine have shown), but more so than regular GPS.
On the customer side, hobbyists soon noticed that a built-in feature previously accessible via the Starlink mobile app allowed un-authenticated network access to a terminal’s precise lat, long and altitude. In this sense, the system could be used as a form of ‘pseudo-GPS’.
It was an unintended consequence with surprisingly accurate results – even SpaceX itself recognizes the potential in this, and its inherent robustness towards interference. In 2025, it advised the Federal Communications Commission (FCC) that Starlink could theoretically act as a back-up to GPS for both the military and civilian applications.
But here’s the kicker – on May 20 this year, SpaceX officially turned off this feature. And we’re still not sure why…
SpaceX closed the door
No official reason was given for the change, but there are a couple of possible explanations:
Explanation 1 – Commercial
SpaceX recently went public, and the Starlink network has been designed and optimized for commercial broadband – an endeavor that yielded multi-billion-dollar revenue last year. So there may be a desire not to dilute its core purpose.
Or it may about access. Blocking location data may be indicative of charging for it in the near future. But we just don’t know yet.
And of course – the legal problem. No one likes being sued.
This is all a side effect of how Starlink works, not an officially supported product. It’s possible SpaceX wants to mitigate any legal liabilities to anyone using unapproved navigation for anything remotely safety-critical.
Explanation 2 – Security
The location feature was a setting that shared a terminal’s coordinates with any device on the local network, with no authentication required. This is a concern because Starlink is actively being used as critical infrastructure in conflict zones. Access to this information can unfortunately be used as a weapon.
It’s plausible that a network or device may be compromised, revealing a terminal’s exact location. This raises fears that it could be used to deliver targeted attacks or for other nefarious purposes.
So where to from here?
Starlink isn’t the answer – at least not yet. Whether SpaceX ever builds on this capability remains to be seen. It has never been an approved source of navigation, nor have any avionics used it.
But it’s one of the few times such a promising alternative to GPS has been this close without needing decades of future development – something worth watching!
Related: Sep 2026 – Starlink prices for business aviation have doubled. We looked at what the changes mean for operators and what they’ll be paying. Read the post.
Seletar 2026: New Corridors, New Procedures
Andy Spencer
17 November, 2026
Last year we wrote about how to survive Singapore’s Seletar, one of those airports where flying a business jet can be a lot more difficult than you might expect. Between the tight airspace, nearby military operations and noise restrictions, Seletar has never been the easiest place to operate a medium or large jet.
Well, some good news is coming our way…
From 29 October 2026, Civil Aviation Authority Singapore (CAAS) is introducing two new Transit Corridors (TC-1 and TC-2) to give aircraft a little more room to manoeuvre when arriving and departing Seletar.
And there’s something else happening on the same day. Honeywell Aerospace will also publish its updated FMS-guided visual approach and departure procedures, which should make life a little easier for suitably equipped aircraft.
I recently attended a CAAS briefing for operators at Seletar, where they walked us through the new procedures and some of the other changes taking place at the airport.
Why do we need Transit Corridors?
The problem with Seletar has always been the airspace. The airport sits in a confined area, with Sembawang airspace immediately to the west and Paya Lebar’s airspace to the east. There isn’t much room to play with, particularly when flying visual circuits in larger aircraft.
Compounding the problem is Seletar’s location, right on Singapore’s northern border with Malaysia. This severely limits the options for instrument procedures. Seletar is a visual-only airport, where even IFR traffic arrives and departs using visual procedures.
The existing visual circuit was very tight, to say the least. As a result, it wasn’t uncommon for aircraft to unintentionally fly outside the Seletar CTR, which isn’t ideal when the airspace next door is crowded with military traffic.
The new Transit Corridors are designed to address this. TC-1 and TC-2 provide defined areas west of the airport that ATC can use for visual arrivals and departures. They give aircraft more room to manoeuvre while keeping them clear of the surrounding airspace.
The trial starts on 29 October and is expected to run until 7 July 2027. If all goes according to plan, these new corridors will become a permanent feature.
So how will it work?
The corridors come with published visual waypoints, altitude restrictions and a maximum speed of 160 knots.
For arrivals, aircraft will join the appropriate downwind and follow a series of visual waypoints through the corridors before continuing to the runway. These waypoints will be available in your FMS database, but don’t let that fool you into thinking this is an instrument procedure. All arrivals remain visual procedures. So it’s best to manually place the waypoints in your FMS to help fly the visual arrival.
For example, a Runway 03 arrival via OMKOM or GUMPU follows RUSSO-SUMEG-TAPUM at 2,000ft, then descends to 1,000ft or as cleared by ATC after TAPUM, continuing via UPLUS and VIDER for the visual approach.
The final is now roughly 2.5nm from the threshold, a huge improvement over the previous 1.4nm final.
Runway 21 arrivals via SJ, PONJO and RECHI use SUMEG to RUSSO at 2,000ft before descending for the visual approach. One thing to be mindful of with the Runway 21 arrival is Malaysian airspace. Flying the downwind through the Transit Corridor is likely to take you into Malaysia, although keeping the base turn tight can allow you to remain within Singapore airspace.
My advice is to apply for a Malaysian overflight permit regardless. They’re relatively straightforward to obtain, and I would recommend applying for both Indonesian and Malaysian overflight permits whenever operating in or out of Singapore. Given how the weather often moves across the island, it is best to have both permits on hand should you need to change your arrival direction.
CAAS was also quite specific about aircraft configuration. Arrivals using the corridors are expected to be in landing configuration and at minimum approach speed, there is a maximum speed of 160 knots when you are positioning for landing or on a departure.
For those of us flying large-cabin jets, this is something worth thinking about before accepting the clearance. You’re going to need to be slow and configured early, so give yourself plenty of time.
Departures are a little more interesting. Straight-out departures remain unchanged. The corridors are only available when ATC cannot accommodate a straight-out departure and needs to route you around the western side of the airport.
For Runway 03, this involves a left turn towards RUSSO at or above 2,000ft, following the published visual routing through SUMEG and RECHI.
Runway 21 departures involve a right turn into TC-2 at or above 2,000ft, before routing via SUMEG and RUSSO. Importantly, TC-1 is not available for departures, so expect to commence the right turn passing 400ft AGL. Again, the maximum speed is 160 knots.
One thing CAAS highlighted was the need to delay thrust reduction and acceleration after takeoff if necessary. The turn should be initiated at the departure end of the runway, and aircraft need sufficient climb performance to meet the corridor restrictions.
For departures, think of it as an NADP 1-style profile. You’ll need to prioritise climb performance over acceleration, potentially delaying thrust reduction and flap retraction to meet the 160kt speed limit and altitude requirements.
Don’t forget, you’re still responsible for remaining within the lateral and vertical limits of the corridors. CAAS made it clear that breaches could result in action against pilots or operators, including operational bans for deliberate or negligent non-compliance.
This isn’t punishment for the sake of punishment. There is training traffic operating at and below 1,000ft, so respecting the published altitudes within TC-1 and TC-2 is particularly important.
ATC will be favouring straight-in approaches, including vectoring aircraft around the western side of Singapore to position them for arrival. If you have a runway preference, tell the approach controller early. Remember that Seletar also has D-ATIS available through ACARS. Communicate early and be upfront about what you need. ATC is here to help you.
Honeywell Aerospace has something new too
On the same day that CAAS introduces the new Transit Corridors, Honeywell Aerospace will also publish its updated FMS-guided visual approach procedures for Seletar, known as the RNAV-H procedures and also visual departures.
For anyone who has flown the visual into Seletar, it’s welcome news that these procedures will be available from the outset. Rather than flying the entire visual circuit manually, the Honeywell procedures provide a defined flight path through the FMS, including both lateral and vertical guidance.
The procedures use Radius-to-Fix (RF) legs, allowing the aircraft to follow the curved tracks needed to navigate the tight airspace around Seletar.
There is one important difference. Because the Honeywell procedures use RF legs, their waypoints are slightly different from those published by CAAS for the Transit Corridors. Honeywell will publish its own waypoints alongside the procedures, so make sure you’re looking at the correct set when preparing for your arrival or departure.
How do I fly it?
My G700 can fly the Honeywell RNAV H procedures using the autopilot in LNAV/VNAV or in Approach mode. I use approach mode and let the aircraft manage the lateral and vertical profile with a FMS generated glideslope.
Both the lateral and vertical guidance are coded into the FMS, including the RF legs needed to negotiate the turns around Seletar’s rather tight airspace.
This takes a fair bit of workload out of the operation, particularly when you’re trying to manage speed and configuration while keeping an eye on the surrounding airspace.
For arrivals, you’ll need to be configured early. CAAS requires aircraft to be in landing configuration and at minimum approach speed when operating within the Transit Corridors. The maximum permitted speed is 160 knots.
For my G700, I have Flaps 20 selected before entering downwind, and then abeam the tower, I select landing configuration. This gives me plenty of time to commence the descent and maintain a stable approach speed.
Departures will require some planning too. Particularly when it comes to managing thrust reduction and acceleration while meeting the corridor restrictions. I remain in takeoff configuration until passing 2000’ when I then accelerate and clean up, whilst reducing thrust to climb thrust.
Although the autopilot is doing the flying, these remain visual procedures. Crews are still responsible for complying with ATC clearances and remaining within the published lateral and vertical limits.
Don’t be tempted to report the field in sight too early. Make sure you genuinely have visual contact with the airport before accepting the visual approach clearance. Once cleared, you’re responsible for remaining within the Transit Corridors.
There are a few catches
Before using the new corridors, operators are required to complete the familiarisation process, and pilots must self-certify that they understand the procedures. CAAS has included the link to this certification process in the AIP SUP.
There are also defined operating windows to work around Seletar’s training schedules. Avoid planning arrivals or departures during these periods, as there is considerable GA activity at Seletar and military training in the neighbouring Sembawang and Paya Lebar control zones.
During certain weekday periods, you can expect delays of around 15 mins. Plan around these windows rather than turning up and finding yourself with an extended delay. The full procedures are published in Singapore AIP SUP 175/2026, which you should review before operating. Do this for every flight, rather than treating it as a one-time briefing.
A few other things from the briefing
CAAS also highlighted several recent safety incidents at Seletar, including two misaligned takeoffs from Runway 03 in 2024.
Following these incidents, changes have been made to the Runway 03 turn-pad lighting, which is now only illuminated when required. CAAS also reminded crews that Seletar does not have runway centreline lights, so don’t expect a row of lights to guide you down the centre of the runway.
Several taxiway hotspots have also been identified, with additional ground markings installed and some taxi routings adjusted to reduce confusion.
Finally, in March 2026, a Gulfstream began its takeoff roll on Runway 21 without clearance. CAAS reminded crews that Seletar normally issues line-up and takeoff clearances separately. A line-up clearance is not a takeoff clearance.
Will this make Seletar easier?
I think the new Transit Corridors are a welcome change.
Anyone who has operated a large business jet into Seletar will know that the existing visual procedures can be demanding. Having a little more room, along with the new Honeywell Aerospace guided visuals, should make life easier. But don’t let the FMS waypoints or guidance fool you. These are still visual procedures, and the relatively tight lateral and vertical boundaries mean they need to be properly briefed.
If you’re planning to operate into Seletar after 29 October, review AIP SUP 175/2026 and check whether you have access to the Honeywell Guided Visual database. Make sure the procedures are available in your FMS and that you’ve completed the required familiarisation and pilot self-certification.
Seletar might be getting a little more room, but it’s certainly not becoming a mini-Changi.
Middle East Airspace – Current Operational Picture
David Mumford
17 November, 2026
Key Points – Oct 19 update
Kuwait has reopened to overflights, restoring the central Europe-Middle East routing option via Turkey-Iraq-Kuwait-Bahrain-Qatar-UAE (for operators permitted to overfly Iraq!)
Saudi Arabia remains high risk. Safe Airspace has raised its warning to Level 1 – Do Not Fly, and we recommend avoiding Saudi airspace entirely.
Houthi attacks have escalated across Saudi Arabia, with repeated missile and drone strikes targeting OERK/Riyadh and other locations, including near OEDF/Dammam and airports in the southwest. OERK reopened on Oct 18 after more than a week of disruption, but the wider threat to aviation remains.
Recent Developments
Oct 19 – Houthi attacks escalate across Saudi Arabia and Yemen
Houthi attacks against Saudi Arabia have intensified, with repeated missile and drone attacks targeting airports. OERK/Riyadh was repeatedly targeted in early Oct, with fatalities and damage to airports.
On Oct 16, missiles struck OYAA/Aden airport in Yemen, landing around 500m from a passenger aircraft preparing to depart for Cairo.
Saudi forces also reported intercepting a ballistic missile headed for Yanbu on Oct 16, plus missiles over the Red Sea and drones over parts of Saudi. The attacks show that the threat extends well beyond the airports in southwest Saudi Arabia.
Oct 18 – OERK/Riyadh reopens
OERK/Riyadh reopened on Oct 18 after more than a week of disruption, but normal ops have not resumed – you need prior permission from Saudi Arabia’s GACA, and the airport is not available as an alternate. Several international airlines continue to suspend/restrict flights here.
Oct 15 – Kuwait reopens to overflights
Kuwait has reopened its airspace to overflights, restoring the central routing option for Europe-Middle East traffic via Turkey-Iraq-Kuwait-Bahrain-Qatar-UAE. The new Notam permits flights between Bahrain and Baghdad FIRs through Kuwait at FL280 or above. However, the route is not available to all operators, as EASA and several European countries advise against or prohibit overflights of Iraq.
Oct 14 – EASA updates Middle East CZIBs again
EASA updated its advice for most countries in the region at the end of Sep, but then they did extra updates for Jordan and Saudi Arabia following that. Basically, Jordan’s situation has eased a bit, and Saudi is facing more frequent Houthi attacks…
Jordan: EASA has eased its advice after no conflict related military activity was reported here over the past month. The risk hasn’t gone away though, and attacks could resume at short notice.
Saudi: EASA now says operators must avoid two areas of the Jeddah FIR at all altitudes (one in the southeast, one in the northwest). This follows increased recent Houthi attacks reaching further into Saudi Arabia including Riyadh.
Bahrain, Kuwait, Qatar & UAE: The Gulf advice has been extended to Nov 16. EASA still says to avoid the airspace over the waters of the Persian Gulf in these four FIRs, except when going to/from an airport.
Oman: The same advice applies to the Gulf of Oman, with EASA recommending that operators avoid the airspace over the water west of 58°E.
Lebanon: The avoid recommendation remains, except for flights to and from OLBA/Beirut over the sea.
Iran & Iraq: Both remain avoid at all altitudes, with the CZIBs extended to Nov 16.
Syria & Yemen: Separate CZIBs remain in place. Syria’s was revised on Oct 1, with EASA now allowing operations above FL260 in parts of the Damascus FIR.
Israel: EASA’s separate Information Note remains in place, advising operators to take the potential risk into account rather than issuing a blanket avoid recommendation.
You can check all the CZIBs and Information notes here, along with some useful background on why EASA has made these changes and what’s been happening in the region.
Current Airspace Picture
The map below tells the short story of your overflight options! Kuwait’s reopening brings the central route via Iraq back into action for those permitted to use Iraqi airspace. Others may need to stick to the northern bypass via the Caucasus-Afghan, or the southern route via Egypt-Saudi.
And now a quick lowdown on what’s going on in each little bit of airspace. One extra thing to note though for all these countries – GPS spoofing/jamming is happening pretty much everywhere! Check below for a link to a map showing live GPS interference…
Kuwait
With Kuwait now open to overflights, the so-called Central Route is back in action for operators allowed to overfly Iraq. It offers an alternative to the southern route via Saudi, where recent Houthi strikes have increased risks. But Kuwait is not completely risk-free – OKKK/Kuwait airport was hit by Iranian missiles as recently as June. Although the threat from Iranian activity has eased recently, the wider regional risk of escalation still remains.
Saudi Arabia
Saudi Arabia remains open to overflights, but the risk picture has worsened significantly. Safe Airspace has raised its warning to Level 1 – Do Not Fly, and we recommend avoiding Saudi airspace entirely, including overflights and the use of Saudi airports as en-route alternates. Recent attacks have targeted OERK/Riyadh, OEAB/Abha, OEGN/Jazan and OENG/Najran, with further reports near OEDF/Dammam.
Yemen
Yemen remains high risk, with Houthi attacks affecting Saudi Arabia as well as government-held areas in Yemen. On Oct 16, two missiles struck OYAA/Aden airport – no casualties were reported, but a passenger aircraft preparing to depart for Cairo was evacuated after the missiles landed around 500m away. Safe Airspace recommends avoiding Yemen entirely. Airspace warnings remain in place, including restrictions on US operators over Yemen’s landmass.
Iran
Iran airspace has reopened to overflights, but there’s still a risk of military activity and air-defence systems mistaking civilian aircraft if the conflict escalates again. There are several airspace warnings in place, and most foreign operators continue to avoid the country.
Qatar/UAE/Bahrain
These three remain open to overflights and landings, and there are still flow restrictions in place. EASA advises avoiding flights over Persian Gulf waters – except when needed for arrivals and departures at the airports here.
Iraq
Iraq is open to overflights – but it’s not available to all operators! EASA and several European countries advise against or prohibit overflights, and US operators are restricted to FL320 and above. Also the recent US/coalition withdrawal from Erbil removes a layer of air defence, particularly in the Kurdistan Region. Some airlines are using Iraq, but most continue to prefer the northern or southern routes instead.
Oman
Oman remains an important route around the conflict zone. EASA advises avoiding flights over Gulf of Oman waters west of 58°E, except when needed for arrivals and departures.
Jordan
Jordan remains open, but renewed attacks in early Sep show that the risk from missiles, drones and air-defence activity can quickly return. However, it’s still not a major transit route for overflight traffic – most operators continue to route via Egypt/Saudi, as they did before the conflict.
Israel
Israel is open, but ops still aren’t back to normal – and the security situation is still a concern. Missile and drone attacks have reduced in frequency, but remain possible including around LLBG/Tel Aviv. Some foreign airlines have resumed services, although others continue to stay away.
Syria
Syria has quietly become part of the regional routing picture again after years of almost no international overflight traffic. Some Middle East airlines are now using Syrian airspace again as an alternative to the more restricted Iran/Iraq option – though most US and European carriers continue to avoid it.
The airspace remains high risk. Israeli military activity and missile interceptions are still a concern, particularly in the south-west. EASA currently says EU operators should stay out of the western/south-western part of the FIR at any altitude, and stay above FL260 elsewhere.
Armenia/Azerbaijan/Afghanistan
Armenia and Azerbaijan remain important parts of the northern bypass, with steady overflight demand. The main issue is still Afghanistan – the OAKX/Kabul FIR remains Class G with no normal ATS service, so crews still need to use the published contingency routes and operate with TIBA procedures.
Where’s the spoofing today?
Still our favourite map to check for this – the live GPS spoofing tracker from GPSwise.
The map detects spoofing in real-time based on the ADS-B data from the OpenSky Network. Handy for a quick look at what’s been happening along your route.
Recent Opsgroup Member Reports
We’ve had a lot of useful Airport Spy reports recently from Opsgroup members operating into several Middle East airports: OMDW/Al Maktoum, OMDB/Dubai, OBBI/Bahrain, OTHH/Doha, OMSJ/Sharjah, OMAD/Abu Dhabi and OEDF/Dammam.
Big theme across all of them is the scale of the GPS jamming/spoofing currently happening around the region. Several reported complete GPS loss on arrival or departure, and interference continuing well into neighbouring FIRs. ATC seems very used to it now, with lots of runway heading departures and radar vectors being issued.
Reports also mentioned fuel delays, extra towing/hangar time, and slower ground handling at some airports. We’ve also had reports of heavy ATC congestion in the OEJD/Jeddah FIR as traffic continues concentrating on the southern bypass via Egypt and Saudi Arabia. Opsgroup members can check Airport Spy in their dashboard for the full reports.
If you have operated in the region recently and could share your experience, send us an anonymous Airport Spy report or email us at team@ops.group.
The Lajes Lowdown: Atlantic Stopover and ETOPS Alternate
OPSGROUP Team
17 November, 2026
In 2001, Air Transat Flight 236, a heavily laden Airbus A330, developed a massive fuel leak midway across the Atlantic and lost power to both engines. Hundreds of miles from land, the crew managed to glide the stricken aircraft to an emergency landing at Lajes, a little-known air force base in the middle of the ocean. Its runway saved the lives of all 306 people on board.
LPLA/Lajes is a large military airfield on Terceira, in Portugal’s Azores Islands, midway across the Atlantic. It sits among the NAT Tracks, about 1,900 NM east of New York and 800 NM west of Lisbon.
The airport was approved for civilian use by Portugal’s aviation authority, ANAC, in 2018. Since then, LPLA has become a popular stopover, refuelling point and ETOPS alternate for aircraft crossing the Atlantic. It now sees a steady flow of bizjets, scheduled airline services, ferry flights and air ambulance.
The Lajes Lowdown
It’s long enough, and strong enough. The fully lit asphalt runway is 10,860 ft (3,310 m) long and 197 ft (60 m) wide, with no weight restriction.
It’s fully IFR equipped.ILS approaches are available in either direction. The runway also has PAPI slope guidance and a Category I approach lighting system.
There’s always someone home. Lajes is the Azores’ only airport fully open all night for emergency diversions. It normally operates 0700-2100, but is available H24 for emergencies, with RFF 8 at all times. ATC, medical support and weather services are available around the clock. In an emergency within Santa Maria FIR, expect to be directed to LPLA.
There’s no carbon tax. As the airport is operated by the Portuguese State through the military, it falls outside the charge applied at LPPD/Ponta Delgada, LPAZ/Santa Maria and LPHR/Horta, as well as at airports across mainland Portugal and Madeira. Depending on the aircraft and operation, choosing Lajes could save USD 2,000 or more. Check the charges with your handler before you go.
Fuel is available. Jet A1 is available through Petrogal/Galp (a reputable Portuguese company) in partnership with WFS, Total Aviation, AEG Fuels, US Government Air Card and AML Global. Cash and credit card payments are also accepted.
It was good enough for the Space Shuttle.NASA used Lajes as an emergency landing site for aborted shuttle launches. Emirates has also used it as a primary alternate for its A380 aircraft crossing the Atlantic, and the USAF and NATO regularly use the airfield for large-scale exercises.
There’s ample parking. The spacious ramp can accommodate the world’s largest transport-category aircraft, including the A380.
It’s an EU entry point. Customs and immigration can process entry to Europe. The terminal has both Schengen and non-Schengen circulation areas.
It has all the usual amenities. The terminal has check-in counters, dining, security, customs and immigration, lounges, ground handling and rental cars. Downtown is about a 20-minute drive away, with accommodation options for crews and passengers.
How do I land there?
You need PPR to land at LPLA/Lajes. Requests are generally processed by Civilian Terminal Ops within a few hours.
If it is just a simple fuel stop you need, refuelling at the airport is also now authorised with passengers onboard.
If you prefer to handle things yourself, you can apply directly here or call airport ops on +351 295 545 461.
However, there are several local handling agents who can take care of clearances, approval, fuel, lavatory servicing and catering for you:
China has introduced a vast 600km-wide area of restricted airspace around Beijing, following a light aircraft crash into the CITIC Tower in June. It’s called ZB(SR)801, and it’s an extra layer of restrictions around the city – the existing Beijing Prohibited Area ZB(P)801 remains in place.
You can still operate through the new area, but there are a few rules to follow: stay in contact with ATC, stick to your flight plan and report your “security status” before entering…
The rules
So for flights into this big new ZB(SR)801 area, a bit more info on the rules:
Keep your transponder switched on throughout the flight.
Stay in continuous contact with ATC.
Report your “security status” before entering (aircraft ID, SSR code, position and whether everything is normal).
Stick to your flight plan. Any changes must be approved ATC before you make them.
Standard speed restriction applies. Below 3000m (9843ft), keep IAS at or below 450 km/h (243 kt). Basically, the 250 kt below 10000 ft rule – as close as you get with metric conversions.
All of this comes from ZBPE Notam A4484/26, so check that if in doubt.
Where to make the report?
The tedious bit that needs a bit of checking for your particular route. ZBPE Notam A4646/26 is the one to check – it lists the reporting point to use when entering the restricted area on each airway. But here’s a copy, in case they incorporate the Notam into the AIP and no one can ever find it again:
Airway
Report at waypoint
B334
TGO
W31
CHG
G212 via TGO
TGO
G212 via BESGI
BESGI
A575 via CHG
CHG
A575 via VANVO
VANVO
G332
CHG
W35
CHG
W201
ORAVA
W576 joining W55
ORAVA
W200
DOVIV
W4
DYN
W569
YQG
W56
ORODO
W62
ORODO
W277
OMBIM
W69
BAXOD
W64
NUTLO
W65
TMR
B458
TMR
W86
TMR
B339
ERVEB
W33
NUVPU
W52
NUVPU
W157
DALIM
W160
YQG
There’s also a separate procedure for aircraft departing ZSJN/Jinan, ZBYN/Taiyuan or ZBHH/Hohhot and entering the area: report your security status to the airport tower before departure.
And the existing little prohibited area around Beijing?
That’s still there. It’s called ZB(P)801 (the little yellow square on our map). It’s GND-UNL, H24, and all flights are banned from entering.
Just one more thing: crews are being tested??
We’ve also been sent something rather unusual from a couple of members operating into ZBAA/Beijing.
It’s a “Special Inspection Checklist – Knowledge check on CAAC NOTAM C0903/26 – Special Restricted Area ZB(SR)801.” It’s basically a three-question multiple-choice test covering the new area, followed by an inspector’s answer key.
The questions cover whether commercial flights need additional approval (answer: no, you just need to follow the rules as per the above), whether ZB(SR)801 replaces the existing Beijing Prohibited Area (answer: no, the existing area is the tiny yellow square over Beijing itself, this new area is the massive 600km one), and what needs to be included in the security status report (answer: as per the rules above!).
The doc we’ve seen is dated Oct 1, 2026. We’ve asked around and haven’t found confirmation that this is happening routinely – but let us know if you know different!
FAA Proposes to Loosen Oxy Rules for Part 91 and 135
Chris Shieff
17 November, 2026
On Sep 24, the FAA published a Notice of Proposed Rulemaking to rewrite the pilot oxygen rules under Part 91 and 135 (a fancy way of saying “we’re thinking about changing the rules, tell us your thoughts”).
This began back in 2024 with the FAA Reauthorization Act. Buried under Section 834, Congress directed the FAA to look at existing Part 135 oxygen rules, taking into account safety data, accident history and NTSB recommendations.
Nothing in the statute covered Part 91: the FAA has added this itself. Why? The FAA addresses this in its proposal:
Same jets but different rules: the same business jets often fly under both Part 91 and 135. The FAA simply sees no point in loosening one set of rules only to leave the other alone.
Backwards safety: there is a long-standing principle that paid passenger and cargo flights should be held to a higher safety standard than private flying. If the rules were relaxed for Part 135, and not 91, we’d end up with stricter rules for private flights which runs against the regulatory grain.
What’s being proposed
Part 135
Two pilots at the controls: Today one pilot has to wear a mask above FL350. It’s proposed to change this to FL410.
One pilot at the controls: Today a mask goes on above FL250 if one pilot leaves the flight deck. Congress asked the FAA to consider FL410 also, but given the time of useful consciousness at that level after a rapid decompression (approx. 9 – 20 seconds) the FAA is a little less gung-ho, and is suggesting FL350.
The same would apply to single-pilot ops too, not just when the other pilot is on the john.
Part 91
Right now, one pilot must wear a mask above FL350 unless there are two pilots, and each has a quick-donning mask. In that case you’re off the hook up to FL410.
The FAA is proposing to drop the FL410 bit. With quick-donning masks within reach of each pilot, it’s proposed that no one will need to wear a mask at any altitude the aircraft is certified for.
This would also get rid of the rule that makes the remaining pilot wear a mask above FL350 when the other pilot leaves the controls.
If your ride doesn’t have quick-donning masks, there’s nothing to see here – the rules won’t change.
What counts as a “quick-donning?” The law has that covered. It means a mask you can get on one-handed, from the ready position, sealed and supplying oxygen within 5 seconds.
This is summarized in the table below:
Why the FAA thinks this is all okay
The FAA’s argument rests on how rarely these aircraft depressurize.
It estimates that Part 91 and 135 operators flew more than 20 million hours above FL250 between Jan 2015 and May 2025. During that time there were around 200 reported decompressions.
Of those, only four were possibly rapid or explosive. Most events were slow – often a door seal noticed during climb. In many cases the crew donned their masks at the first sign of trouble.
Then there’s design. Under certification rules, a ‘realistic’ pressurization problem (like losing a bleed source, or a stuck outflow valve) shouldn’t let the cabin altitude exceed 40,000ft. It also shouldn’t stay above 25,000ft for more than two minutes.
A sudden major loss of cabin pressure isn’t covered by this limit, but the certification treats this as so unlikely that it can be excluded. It basically almost never happens.
It’s also important to acknowledge that the existing FAA rules are stricter than ICAO’s, which only require quick-donning masks to be available above FL250, with no requirement to wear one.
And finally, if you’re feeling the pinch at the grocery store, there’s some money to be saved. The FAA says the proposed rules will save on oxygen servicing. A bottle refill typically costs $100 – 400, and every 1% of affected operations that skips a service will save $4.7 – 18.6 million a year. That’s a of a lot of hot dogs.
The FAA isn’t ignoring basic physiology
There’s no denying that the time of useful consciousness gets perilously short at the levels modern business jets are cruising at. The FAA’s own table confirms it.
These numbers come from chamber studies with people sitting still. I’d wager that if you add flying, noisy alarms, mist, sub-zero temperatures, barotrauma, startle factor and a cockpit that is suddenly extremely busy the times get shorter still. That’s why the FAA suggests you use the lower number as a more realistic figure.
But it’s about balancing practicality and risk. The proposal suggests the odds are low enough to accept.
Do you agree?
That’s why the proposal is open for comment until Nov 23. Remember, right now the existing rules still apply! Nothing has changed yet.
If you have real-world experience with decompressions (especially rapid ones) the FAA wants to hear from you, and so do we. We’d love to share your story. You can reach us at blog@ops.group – and of course, we’re glad you’re okay!
Australia TSP Lite Explained
OPSGROUP Team
17 November, 2026
If you’re flying into Australia, you’ll need a Transport Security Program (TSP) approval – and for international operators, getting one can be a tedious, doc-heavy process. But the good news is that there is a TSP-Lite version that you can apply for!
The Dept of Home Affairs calls this a “Secretary-Issued TSP – a simplified way for operators who meet certain criteria to apply for a TSP”. The application is much shorter than the standard TSP process.
It’s aimed at operators who are only flying to Australia now and then, rather than running a regular operation. The Department will review your operation and let you know whether TSP Lite is available or a full TSP is needed.
Do you qualify for the TSP-Lite?
Yes, if you can answer YES to all of these questions (the first two are the big ones):
Your flights are private or charter operations and not operated on a fixed schedule or route; and
You do not have temporary or permanent operational facilities in Australia; and
You do not allow passengers or aircraft operator staff to enter the landside security zone (sterile area) of a security controlled airport; and
You do not allow passengers or aircraft operator staff to mix with other passengers of prescribed air services in airside areas; and
The form itself is pretty straightforward, but there’s a bit of hassle with the 3 attachments which basically tell the Department who you are, what you’re planning to do in Australia, and who is looking after security.
Attachment A: your operator and key contacts
Tell them who the operator is and who they should deal with. You’ll need to nominate a Security Contact Officer and an alternate. The Security Contact Officer needs to be your own employee with operational control – not some random agent or ground handler.
Use the legal operator’s company email address for these contacts where possible. Just recently, an OPSGROUP member found that mixing personal and company email addresses created unnecessary delay.
Attachment B: aircraft and planned operation
This is where you tell them what you’re actually planning to do.
Give them some useful detail: the aircraft you’ll use, what sort of flying you’re doing, how often you expect to visit Australia, and your likely routing and arrival airports, etc.
In other words, don’t just write “private flight to Sydney” and leave it at that!
Attachment C: how security is managed
This one is basically – who is responsible for security, and what do they actually do?
A short description/table/organisation chart is fine. Also use job titles rather than individual names.
One member said they were also asked for a management chart identifying the Safety Officer. The form asks for a Security Contact Officer, so make sure both roles are clear if they’re separate, or explain how one person covers both!
Before you press send
One thing to watch – tech stops!
One member was asked how the aircraft would be kept secure while on the ground.
So if you’re planning to use remote or unfamiliar airports – be ready to explain where the aircraft will park, who can access it, and what security will be in place until departure.
Apply early
Expect the process to take at least 60 days.
One member said they applied less than 60 days before departure and received approval only shortly before departure after being asked for more info. An expedite helped in that case, but it may not always work.
So apply as soon as you know the core operation! You can update the Department if things change, but getting a complete application in early is the much safer option.
Below 45.5 Tonnes: What Difference Does It Make?
Andy Spencer
17 November, 2026
Key Points
Getting below 45,500kg can make a difference. If your aircraft is above this threshold, reducing its certified MTOW below 45,500kg may make it easier to access some airports and avoid certain security/permit/slot/parking issues.
Check with your handler before you go. Ask whether a lower weight could make a difference at that specific airport.
Don’t assume it will reduce your charges. EUROCONTROL and some airports may still use the aircraft’s original MTOW when calculating charges.
Back in 2023 we wrote about the 45.5 tonne elephant in the room. At the time, we were looking mainly at the UK where the latest generation of large-cabin business jets, such as the Gulfstream G700 and Bombardier Global 7500, had suddenly found themselves on the wrong side of an important security threshold.
It turns out this isn’t just a UK problem. The same 45,500kg line exists across Europe, and if you operate something like a G700 or Global 7500, it can have a surprisingly big impact on where you can go and how you operate.
But the good news is that some of these aircraft can have their certified MTOW reduced below the 45.5 tonne limit…
What’s so special about 45.5 tonnes?
Under UK and European aviation security rules, some private and company flights below 45,500kg are allowed to operate under alternative security arrangements. In other words, they might not need screening.
Once your certified MTOW hits 45,500kg or more, things change. Generally, both you and your passengers will need to be screened. It no longer matters whether you’re commercial (i.e. Part 135) or private (Part 91). This can be a big deal for an owner who isn’t used to being sent through a body scanner, or having their LV luggage rummaged through by a security guard.
Up until the latest generation of Gulfstreams and Globals, it never really mattered for most business jets. But much like our waistlines, the newer flagship jets have grown.
Some airports become a problem
EDMO/Oberpfaffenhofen is a good example. If you’re above 45.5 tonnes and carrying passengers, the required security screening becomes an issue. Smaller airports like EDMO don’t necessarily have the screening facilities needed to handle you. That can leave you with few options – operate a crew-only ferry, use another airport, or reduce the aircraft’s certified MTOW.
Both Gulfstream and Bombardier have recognised the problem. Bombardier has Service Bulletins available to reduce the certified MTOW of the aircraft, while Gulfstream has an ASC which does essentially the same thing. Both these options come at a cost, but they can be a great option when you’re planning that summer European vacation with the boss.
Your 45.5+ tonne jet can therefore go on a paperwork diet and come out the other side below the magic number.
Problem solved? Not quite…
Not everyone recognises the diet
The UK allows the lower certified weight to be used without too much drama. Apply the applicable aircraft change and, from a security perspective, you can use the lower weight. In my experience with our G700, this means providing the signed aircraft logbook page and the relevant ASC from Gulfstream.
But across Continental Europe, things can be different. In several countries, including Switzerland and the Netherlands, the weight on your state-of-registry noise certificate needs to match the reduced weight you’re trying to use. Simply turning up with an ASC or Service Bulletin saying your aircraft is now below 45.5 tonnes may not be enough.
Having spent the last few summers operating in Europe, my advice is to check what paperwork your state of registry will issue to support the lower MTOW. This is something worth sorting out long before the aircraft is heading to Europe.
These weight changes have to be applied in the way the manufacturer requires, and often that means your engineer needs to be the one to sign it off in the aircraft’s logbook. So just make sure you prepare well in advance.
It’s not just about security
There is another reason the 45.5 tonne diet can be useful: permits, slots and parking.
LFKF/Figari is a good example. Summer is the busy season, and getting a private turnaround flight into Figari below 45.5 tonnes is not terribly difficult. But if you’re carrying some extra winter weight and end up above the threshold, your permit application can be treated alongside commercial traffic.
Now your G700 or Global is fighting for the same limited airport capacity as the airlines. That can make slots and parking considerably harder to get, particularly during the summer when Figari is already rammed with airline and leisure traffic.
So if you’re going to use the lower MTOW, tell your handler from the start. They’ll need to know before they apply for permits and slots, as the lower weight could make a difference.
EUROCONTROL still thinks you’re fat
There is one place where the diet won’t help you!
EUROCONTROL still uses the manufacturer’s standard MTOW when calculating your route charges. And you’ll also find the same thing with many airport charges – most use the highest listed weight as their standard, and there’s not much room for negotiation.
So you can lose the weight for security, but somehow still be too fat when it comes to the bill ✈️ 🍽️ 💵
NAT Pack 2026: All the North Atlantic goodies
David Mumford
17 November, 2026
The new OPGROUP NAT Pack 2026 is now available! This is a big bumper combo pack with all the North Atlantic goodies you will need for a successful crossing!
What’s inside?
All of the below!
1. NAT Oceanic Checklist: A combination of NAT Doc 007 guidance, member additions, and safety guidance from OPSGROUP. Valid September 2026.
2. NAT Plotting Chart: This is a Hi-Res North Atlantic Plotting and Planning Chart in PDF format showing North Atlantic Oceanic Airspace, Shanwick, Gander, Reykjavik, Bodø, New York, Santa Maria, and adjoining domestic airspace, with easy-to-read NAT Tips, Airspace requirements, Emergency procedures, and much more! Updated June 2026, with updated Iceland-Greenland corridor, VHF routes, BIRD ADS-B requirements, removal of Blue Spruce routes, Greenland alternates, additional diversion airports.
3. “My first NAT flight is tomorrow” NAT Guide 2026/27: This NAT Ops Guidebook covers (we hope!) everything you need for both a routine crossing (but still complex), and non-routine (eg. No HF, No HLA, No RVSM) ferry flight. Read the latest 2026 changes, easy to read guidance, sample flights, Flight Planning codes, ATC contact numbers, Diversion airports guide, VHF coverage, Oceanic Clearance vs RCL – all in one single guide.
4. NAT Airspace Circle of Entry 2026/27: clearer view of NAT HLA, DLM, surveillance areas, and where datalink is or isn’t required.
5. The OPSGROUP NAT Annual 2026: This annual covers all the briefings we’ve sent to members about the NAT, including: Blue Spruce Routes have gone (but you can still fly them), FIRE on the NAT – Where to go in an Emergency, GPS Spoofed before the NAT?, FAA NAT plotting info, NAT contingency procedure 1-page guide, Gander Eastbound: Crew Brief & Checklist
6. NAT Library: A current copy of NAT Doc 007, and the GOLD document.
Option 2: Join OPSGROUP, and get it for free! With an OPSGROUP membership, all publications like this from the group are free of charge and all available through the Member Dashboard. Join with an individual, team, or airline/dept membership, and connect with over 10,000 other pilot, dispatch, ATC, and operations members.
New 2026 NAT Oceanic Checklist
OPSGROUP Team
17 November, 2026
The new OPSGROUP Oceanic Checklist is now available!
Thanks to all members who worked on this, it looks very useful! The checklist is a combination of NAT Doc 007 guidance, member additions, and safety guidance from OPSGROUP. Valid September 2026.
Next week the complete NAT PACK 2026 will be published, which will be a big bumper combo pack including the NAT Plotting Chart, NAT Guide (My First North Atlantic Flight is Tomorrow), Circle of Entry, this NAT Checklist, plus a bunch more. Keep an eye out for that in your member emails.
With an OPSGROUP membership, all publications like this from the group are free of charge and all available through the Member Dashboard. Join with an individual, team, or airline/dept membership, and connect with over 10,000 other pilot, dispatch, ATC, and operations members.
The Bahamas wants your cash
Kateřina Michalská
17 November, 2026
The Bahamas wants your cash! And they’re finding plenty of ways to get it. So far, we’ve got:
backdated invoices for increased landing and overflight fees
a proposed overflight charge
rising airport fees
So here’s a look at each…
Backdated fees
The Bahamas Air Navigation Services Authority (BANSA) is retroactively charging landing and overflight fees for flights dating back to May 2021!
The charges apply to private and commercial ops alike. They are based on your aircraft’s maximum take-off weight (MTOW) and are reported to be around 300% to almost 700% higher than the previous rates.
They also come on top of customs, airport authority and FBO fees. So even if you paid BANSA at the time, you may now be asked to pay the difference between the original charge and the new rate.
The following ops are exempt:
Search-and-rescue or emergency medical services flights.
Aircraft making an emergency landing at an airport other than their intended destination.
Private flights in single-engine piston aircraft.
Aircraft owned or chartered by the Bahamas government.
Aircraft belonging to the armed forces or governments of ICAO member states.
So basically no one. If you’ve operated a twin piston, turboprop or jet aircraft to/over the Bahamas since May 2021, expect an invoice.
BANSA has also indicated that an aircraft with an unpaid debtmay be seized or detained by the Bahamas government if the operator refuses to pay.
Invoices were initially coordinated through IATA’s Simplified Invoicing and Settlement (SIS) system. However, communication with BANSA appears to have stopped (reportedly on government instructions), and IATA is also understood to no longer be participating in the process.
If you do receive a retroactive invoice, NBAA wants to hear from you. The association is working with affected operators and the US government to challenge these charges. NBAA also questions their basis, pointing out that the FAA provides most air traffic services for the Bahamas while charging only a nominal annual fee!
A proposed USD 775 overflight fee
As if the retroactive BANSA invoices were not enough, another proposal could make flights between the southeast US, the Caribbean and South America significantly more expensive.
The Bahamas Aviation, Climate and Severe Weather Network Ltd (BACSWN) is seeking ICAO approval for aUSD 775 overflight fee. USD 500 would go to the Bahamas government and USD 225 to BACSWN.
If applied across the current BANSA charging area, that could addUSD 775 per flight. This would be separate from the existing BANSA fee, although it is still unclear whether it would eventually replace it or be charged on top.
There are other major unknowns: Which aircraft would be affected? Would the charge would apply only to overflights or also to flights to/from/within the Bahamas? Would the BANSA charging area would be used for the new fee? etc!
For now, this is only a proposal. There are still plenty of unanswered questions about who would pay and where the charge would apply. But if it goes ahead at USD 775 each way, it might be worth looking at ways around it – maybe going via waypoint NUCAR to the north, or Cuba to the west if you can get an overflight permit for it.
Some Bahamas airports are getting more expensive too
Costs are rising on the ground as well. In 2023, the Bahamas Airport Authority started a process to move the management and redevelopment of 14 Family Island airports to private companies under 30-year agreements. An outfit called Island Airport Development Partners is now reportedly taking over three of them:
MYEH/North Eleuthera
MYEM/Governor’s Harbour
MYEF/Exuma
There are only a handful of airports in the Bahamas with jet fuel and runways long enough for most jets. MYNN/Nassau and MYGF/Freeport can be busy for a simple fuel stop, while MYIG/Matthew Town on Great Inagua is too far south for many flights. That makes MYEH/MYEM/MYEF useful alternatives.
A new pricing schedule is proposed for these three airports from Jan 2027, although it is still under review by the Bahamas government. If approved, passenger fees would be USD 66 per international pax and USD 33 per domestic pax. Landing and parking fees would also increase.
CST Flight Services compared 2026 charges with the proposed 2027 rates for a 4-night international stay at MYEM with four passengers. Total airport costs would increase by 84% for a Pilatus PC-12 and 92% for a Hawker 800.
The full impact on FBOs is still unclear. If the new airport charges apply to FBO terminals and ramps, they are likely to be passed on to you. And if airport rents for FBOs increase, handling costs could rise again. More airport handovers may follow, so the impact may extend beyond general aviation and eventually feed through to commercial fares too.
Watch this space…
So if you’re heading to the Bahamas, expect to pay more! And in some cases, you may not even know exactly how much until the bill arrives. The BANSA charges are already happening, the new overflight fee is still being worked on, and airport fees are going up too. We’ll keep an eye on all of this and update you as things become clearer.
Thanks to Rick Gardner and CST Flight Services for their help in putting this article together. If you need support with your Bahamas ops, you can contact them at info@cstflightservices.com.
Can I open the aircraft door on arrival in the US?
David Mumford
17 November, 2026
An OPSGROUP member operator recently reported getting into trouble after opening the aircraft door when they saw CBP officers approaching.
This may sound like a familiar story! Crew land, open the door, CBP aren’t happy. They’re told they’ve opened the door without permission, and things get fairly heated. No fine was issued, but obviously the crew wanted to know: is this actually a rule?

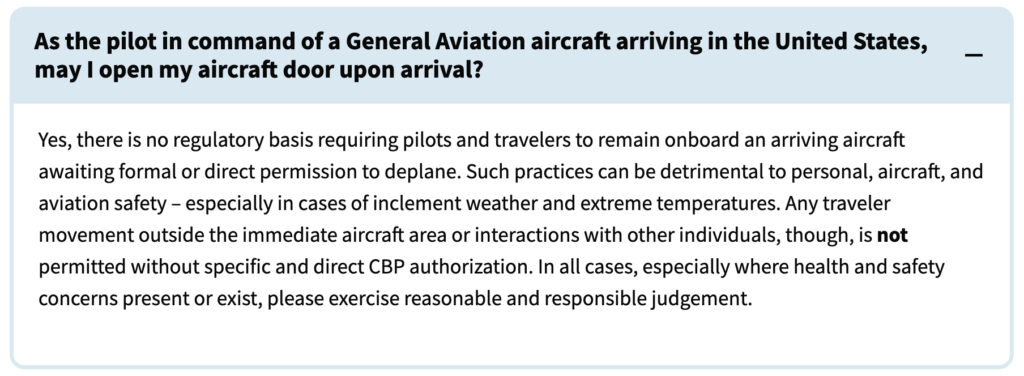

We checked with CBP, and the answer is pretty clear: yes, you can open the door on arrival.
The nuance is that thing about not being allowed to leave the plane. So yes you can open the doors, but no you can’t just wander off after you do.

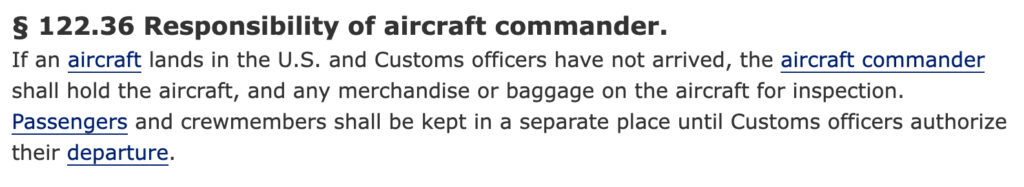

We’re pretty sure that second part comes from this rule in 19 CFR 122.36:
So why are some airports telling crews otherwise?
Good question. Since we shared the incident above, we received a medium-to-large flurry of emails from members being told to keep the door closed at several different airports. So it’s definitely not a one-off.
One was even told the reason was that CBP needed to carry out some sort of radiation scan outside first, before opening up the aircraft. We can’t verify that one!
And yet at some airports the procedure seems to be almost the opposite – we had a few reports saying that in some places local CBP gets annoyed if the crew doesn’t get out and go into the CBP office.
So the procedure does seem to change a bit depending on where you land.
Worth checking before you go! These docs contain local arrival procedures, operating hours, contact details and other stuff.
We looked at a few of these (especially the airports where we had reports of crews being told they weren’t allowed to open the door until CBP arrived!) and we couldn’t find anything about doors.
What to do?
Check the local CBP factsheet and follow whatever specific procedure it says.
But if there’s no door-related rule written down anywhere, and you’re told “you can’t open the door until CBP gives you permission”, it seems reasonable to ask where that requirement comes from!
CBP HQ guidance is clear: there is no general requirement to keep the door closed. Just remember that opening the door doesn’t mean you’re cleared to leave the aircraft area – wait for CBP to complete the arrival process.

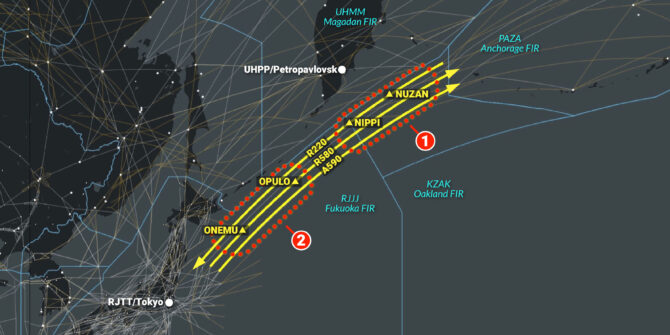

GPS trouble on the North Pacific routes
Andy Spencer
17 November, 2026
GPS interference is becoming more of a regular problem on the North Pacific routes between Asia and North America. We’ve had several member reports over the past few months, and last week I flew through the affected areas myself.
Here’s a map of what’s going on:
The first area – Kamchatka
The first reports started around Kamchatka in June. FAA data shows more than 100 civil aircraft have been affected around NUZAN since then. The reports span the Anchorage Oceanic and Magadan West FIRs.
Most crews reported GPS jamming – at least four reported possible spoofing. One of our members was westbound on R220 in a G650 when they lost GPS completely between NUZAN and NIPPI. ADS-B and synthetic vision disappeared with it. When the GPS returned, it appeared to be spoofed, with incorrect altitude and time. The whole event lasted almost 50 minutes.
The second area – Kuril Islands
In late July, reports started appearing further south around the Kuril Islands, in the northeastern part of the RJJJ/Fukuoka FIR.
Between July 22 and Aug 3, the FAA received six reports here – four jamming and two spoofing. Four aircraft were eastbound towards Anchorage, while two were westbound towards Tokyo and Seoul.
We’ve had more reports since then. R580 has been affected from around 100nm north of ONEMU through OPULO, with aircraft on R220 reporting problems too.
On Sep 10, one of our members was flying to Japan on R220 when they got intermittent GPS interference between NUZAN and NIPPI. They were at FL400 at the time.
So whatever is going on up here, it hasn’t gone away.
We flew through it last week
I flew R580 through the area last week in a G700. Knowing about the previous reports, we briefed the expected interference area on the ground and marked it on our flight plan package.
I also put fix rings around the expected entry and exit points in the FMS.
As we passed through, we monitored the GPS status page closely for any degradation or loss of satellites – but we saw… nothing! We had no problems in either direction. I’ll be back through there again next week, and we’ll do exactly the same thing.
The latest Notam
Update Sep 18: We now have a specific PAZA/Anchorage Notam for the Kamchatka area, saying there have been multiple reports of interference along R220 between NUZAN and NRKEY. Most reports have been short, and the source is unknown. Crews are asked to report how long the interference lasts and what it affects:
A2576/26 NOTAMN
Q) PAZA/QMNGW////000/999/7456N15444W005
A) PAZA
B) 2609182048
C) 2610312345
E) ATTENTION AIRCRAFT OPERATING IN THE ANCHORAGE ARTCC OCEANIC FIR.
MULTIPLE REPORTS OF GNSS INTERFERENCE, JAMMING AND POSSIBLE SPOOFING
HAVE BEEN RECEIVED ALONG ROUTE R220 NUZAN, AK TO NRKEY, AK.
MOST REPORTS ARE OF SHORT DURATION. SOURCE UNKNOWN.
IF EXPERIENCED, REPORT DURATION AND AVIONICS IMPACTS TO ATC.
F) SFC
G) UNL
But there are still no GPS interference Notams for the area around the Kuril Islands, the RJJJ/Fukuoka FIR, or any nearby Russian airspace either.
We also spoke to the team at GPSwise. They don’t have any reliable data from this area either, so for now it’s a bit of a black spot.
So if you’re flying the NOPAC routes, particularly R220 or R580 around Kamchatka and the Kurils, it’s worth briefing the known areas before departure. And if you get hit, please do send us a report!
The Luton Noise Trap
Chris Shieff
17 November, 2026
An OPSGROUP member was recently caught off guard by a day-time noise violation while departing EGGW/Luton in a Falcon 7X.
Despite flying the published departure procedure accurately and easily meeting the AIP’s only climb requirement, they busted the day-time limit of 79 decibels by 0.6. The result was a fine of £1250 GBP ($1700 USD).
While being fined for a six tenth of a decibel sounds harsh (and it is), strict enforcement of noise is common at many airports around the world.
What bothers us here is the lack of clear guidance at Luton as to what to fly, and getting stung nonetheless – there’s no published NADP procedure, and for pilots the rules are murky at best.
Welcome to the Luton noise trap…
How do we hit the number?
Things work a little differently at Luton. Rather than prescribing a vertical climb profile (NADP 1 or 2), the airport relies on Noise Preferential Routes (NPRs) to keep departures away from sensitive areas. Lateral track accuracy is essential, until reaching the prescribed day or night ‘release altitude’ – 3000 ft and 4000 ft respectively.
There isno NADP procedure – in fact the airport confirmed it has no plans to mandate one because in their own words ‘individual airlines require different procedures.’
Our member flew the NPR correctly and met the only climb requirement in the AIP – a minimum of 500 fpm, not exactly difficult in a Falcon. And yet they still found themselves in hot water.
Here’s why – Luton concurrently runs a noise-monitoring program. You won’t find it in the AIP, it’s buried in the airports’ Charges and Conditions of use.
Since January this year, the daytime limit is 79 dB and 78 dB at night. This is tracked by ‘noise monitoring terminals’ nestled in the surrounding suburbs. Fines of £1250 ($1700 USD) and £2250 GBP ($3050 USD) apply if you bust the limits.
The flight in question (a 7X near max take-off weight on a warm summer’s day) measured 79.6 dB and triggered a fine.
Here’s what we don’t like about this.
Crew are being left with decibel limits with no guidance on a profile that will achieve it – if you happen to know how to operate your aircraft to within 0.1 of a decibel, please let us know.
In fact, the only additional guidance in the AIP is pretty vague. It contains a general instruction to climb at “power settings which will ensure progressively decreasing noise-levels.” Hardly earth-shattering advice.
What the data had to say
The operator here asked the airport authority about the fine in question, who in turn pulled the actual data.
It seems the noise event was recorded at 2900 ft – just 100 feet below the daytime release altitude.
The included graph did indeed show that the incident flight was flying a slightly shallower gradient than most other departures. Despite what the AIP says, it appears many other operators are informally applying their own NADP to steepen their initial climb, most likely to avoid the same trap.
But it’s a workaround, because unlike the payment of the resulting fines, the airport doesn’t mandate it. It’s simply left up to the operators – and for that, we cry foul.
So what’s the answer?
The case above shows that you can’t rely on the AIP alone to protect you from a fine – especially when performance is limited (hot, heavy etc). Your best protection is to apply an NADP anyway. ICAO defines two of these:
NADP 1 (noise near). Maintain V2 + 10 – 20 kts and delay flap retraction until reaching 3,000 ft AGL, while reducing power at or above 800 ft. This keeps your aircraft close-in and configured, which reduces noise nearer the runway. This is what we suggest for Luton.
NADP 2 (noise distant). Early acceleration and flap retraction (usually 800 ft AGL) and then maintain your designated manoeuvring speed until 3000 ft AGL. This means that noise reduction is spread out further from the airport since you’re climbing faster and higher sooner. This trades close-in quiet for less noise down the track.
Here’s a handy summary:
Do you know of other noise traps?
Luton probably isn’t the only airport with these kinds of issues. Do you have one to share? Please reach out to us so we can share it with the group. You can reach us around the clock at blog@ops.group.
India puts a three-aircraft limit on permits
David Mumford
17 November, 2026
India have made some changes to their rules for permit requests. The big one is that you can now only put three aircraft registrationson a request: one primary and two alternates.
Word on the street is that some operators were putting their entire fleet on the application, so they could use pretty much any aircraft if the planned one went tech. And it seems the DGCA wasn’t too keen on that!
So for an operator with a fleet of 20 aircraft, that makes things a little more interesting. Pick the wrong three and you’ll need to get the permit changed if you end up using another aircraft.
The new guidance was issued in an email from the DGCA on 19 August 2026, which went like this:
Lots of words there, friends. But the main things worth mentioning from that list:
You can submit a permit request no more than 10 working days before the flight. So you can’t get too far ahead of yourself.
For changes to the permit, the DGCA say this will only be considered in exceptional circumstances. But local permit agents tell us that in reality this is not normally a problem, and as long as you get your change request in during DGCA working hours they can get it changed within 6 hours. Contact them at ops@srcaviation.com to do the needful.
But either way, if your aircraft goes tech, don’t leave the permit change til the last minute!
One More Question
Here’s something we asked, thinking we might’ve thought up a clever work-around:
For an operator with more than 3 aircraft who doesn’t know which aircraft will operate the flight, can they submit multiple permit applications (with up to 3 registrations on each) and obtain multiple permit numbers, then use whichever permit covers the aircraft actually operating?
The answer: no.
So that was the end of that.
Standard Permit Rules
One other thing to note is this new thing about max-three-planes-on-permit-requests is for all for non-scheduled/private permit requests – not scheduled airline ones. The India AIP says that private/charter/bizav/non-sched flights all fall into the same bucket when it comes to permit requests – they basically all follow the same process.
Expect 24hrs lead time for overwater flights and 3 working days for flights crossing Indian landmass.
And on that point…
Overwater Flights
You don’t need a permit if you’re not overflying India’s landmass. Kinda interesting, but not actually very useful for most overflights between the Middle east and Asia as all the airways cross the land.
But worth knowing if you’re maybe planning a flight to the likes of VRMM/Male in the Maldives! (Can’t think of anywhere else where this no-permit-required-for-oceanic-flights would actually be useful, can you?)
The Pakistan Gotcha
Not really a gotcha, because no one has a plane registered in India or Pakistan. And if you do, you’ll know this already.
But here it is anyway. India and Pakistan have had reciprocal airspace bans in place since the 2025 conflict, and they’re still being extended – so Indian reg aircraft still can’t use Pakistan airspace, and vice versa.
Starlink Business Aviation prices have doubled
Andy Spencer
17 November, 2026
Starlink has doubled the price of its Business Jet plans. For those of us who already have Starlink on the aircraft, the new prices kick in from the next billing cycle starting on or after 7 August 2026.
So we’re talking about the full-size Business Jet terminal here. Aviation Mini is a separate product and isn’t affected.
Before the change, there were two plans:
Plan
Price
Data
Business Aviation 25GB
$2,000/month
25GB
Business Aviation Unlimited
$10,000/month
Unlimited
(side note of semi-interest: the old Aviation Jet 20GB plan was renamed Business Aviation 25GB earlier this year, with the allowance increased to 25GB)
There are now three:
Plan
Price
Data
Coverage
Aviation Regional 25GB
$4,000/month
25GB
One region
Aviation Regional Unlimited
$12,500/month
Unlimited
One region
Aviation Global Unlimited
$20,000/month
Unlimited
Worldwide
(side note of likely more interest: hardware and installation cost has gone up too, although that’s a one-off cost and varies depending on where you get it installed)
So some big price increases all around!
Regional vs Global
Starlink has divided the world into six areas (see maps below), and a Regional plan only works inside the region you have selected. You can change regions during the month, but if you cross the boundary the service stops as soon as you leave your selected region! It won’t switch you to Global Unlimited automatically – you’ll need to contact Starlink and change your region to get it working again.
Regional coverage also includes ocean inside the region, so the Mediterranean for example is covered as part of the Europe region.
So the basic lowdown is this:
Regional: Stay inside your selected region and the Regional plan works just fine. Cross the boundary and the Starlink stops!
Global: Pay through the nose for the Global plan and do whatever you like! (although there are still some countries where Starlink doesn’t work: China, Taiwan, Myanmar, Turkey, India).
What the regions actually look like
So here’s what Starlink’s six boundaries for the Regional plans look like:
Bottom line
If you stay within one region, you’re looking at $12,500 a month for unlimited. If you need worldwide coverage, it’s $20,000. The service itself hasn’t changed (it’s still VERY fast in the air), it’s just that we’re now all going to be paying a hell of a lot more to use it!
The CARICOM eAPIS is going away
Chris Shieff
17 November, 2026
On September 30, the CARICOM eAPIS portal (the website operators have used for years to submit Advance Passenger Information) is being retired.
In its place is a new system called CARICOM MDEX, which is short for Manifest Digital Exchange. You can find it at carimdex.org, and it’s about to take over as the region’s official APIS platform.
What does this mean operationally?
If you’re unfamiliar with CARICOM, it refers to The Caribbean Community. It consists of fifteen member states that span the Caribbean including Jamaica, Barbados and Trinidad to name a few. You can view the full list below:
All flights (both commercial and private) are required to submit Advance Passenger Information (API) before departing or arriving in a CARICOM member state. If you need a refresher, see the official APIS submission rules.
This isn’t new – nothing about what you submit is changing, it’s just how you submit it. From October 1, the old eAPIS site will be turned off. Moving forward, you will need to use the MDEX portal to submit API instead.
What to do right now
We suggest you don’t wait until the deadline to get set up. If you leave it to the last minute and run into issues, you won’t be able to dispatch.
You can register for MDEX now. A full PDF has been produced with instructions on how to register and submit your APIS details, and it all seems pretty straight forward. See the MDEX registration guide.
There’s also a bit of housekeeping on the back-end. Don’t forget to update any automated upload process that is tied to the old system. If your operation submits API data automatically instead of logging in manually, don’t assume it will just keep working. MDEX is a new platform, so anything linked to the old caricomeapis.org will need to be redirected with new credentials. Take a look at the Portal API Docs link on the MDEX site for more info.
Don’t miss the boat come September 30, hop aboard MDEX now.
Mayday!
If you need help with the migration process or getting your account working, you still have time. Reach out to apis-support@impacsjrcc.org
Haneda Says: Three Strikes and You’re Out
Chris Shieff
17 November, 2026
Japan’s CAA (JCAB) is clamping down on pilot deviations, and is rolling out a three-strike system for captains at Tokyo’s RJTT/Haneda.
It works like this: a pilot who accumulates three qualifying deviations from ATC instructions will be come a ‘restricted’ captain. Find yourself on that list, and you will lose the ability to serve as PIC there.
Universal confirms these rules apply to international BizAv – the crews most likely to be unfamiliar with Haneda’s tight and high-density airspace.
So here’s everything you need to know before you step up to the plate.
The core policy
Before we start, it’s important to note this new policy is PIC-specific.
When it comes fully into effect, operators will need to declare the PIC’s name, licence number and contact info on the Airport Use Plan – the pre-arrival paperwork that international operators need to file with JCAB before operating into Haneda.
If ATC flags a deviation (e.g. runway/taxiway incursion, clearance bust etc) they will review the circumstances and decide whether to log it against the PIC or not (not all deviations will count). If it’s confirmed, the PIC’s name will go on a naughty-list the JCAB refers to as ‘Watchlist of Captains Requiring Special Attention.’
Once a PIC has accumulated three “strikes” (qualifying deviations), they will become a ‘restricted captain.’ This means they can no longer act as PIC on flights in or out of Haneda. They can still fly there, just not in command.
Things to note
Deviations will be logged against the PIC’s name, but operators won’t totally dodge the ball either. If a restricted captain is listed as PIC, the operator will be asked to swap in a different captain. Refusing that may place the operator’s own access to Haneda at risk.
But here’s some better news. The number of strikes against a PIC’s name will decrease by one after each full year passes with no further deviation, after which they’re free to operate again.
Why the change?
There was a string of ATC deviations by foreign BizAv crews through 2025. JCAB was sufficiently concerned that it issued an advisory in October last year to address this. It included two serious examples of one aircraft entering Runway 04/22 without a clearance, and another entering a closed taxiway, A1.
The advisory asks operators to make sure they check the AIP, SUPs and Notams carefully. If there is any doubt over your clearance, they want you to stop before entering a runway and actively confirm ATC’s instructions.
And of course, underpinning all of this is the tragedy of Jan 2, 2024, when an Airbus A350 collided with a Dash 8 on Runway 34R. Since then there has been a significant push to improverunway safety at Haneda, including changes to several ATC procedures.
New (ish) Safety Bulletin
In March this year, Haneda’s ATC office, along with Japan’s national government ministry published an extremely useful bulletin that provides a fairly comprehensive list of the kinds of things we’re getting wrong out there. These are covered in detail in the bulletin, but here’s a sneak preview of the main ones.
Taxiway Confusion:
The bulletin places a heavy emphasis on the mis-understanding on taxiway clearances – take one look at the airport chart and you’ll understand why.
There are several well known hotspots. Rather than blurt out a senseless series of taxiway designators, Tokyo’s Runway Safety team has summarised these into one handy graphic:
Incursion Prevention:
This one’s a reminder from an AIC published in the aftermath of the A350/Dash 8 collision. It may seem like common sense, but a sequencingcallfrom ATC (such as No.1/No.2) is not a clearance to enter the runway. In fact there are only four phrases that let you do that:
Cleared for take-off.
Line up and wait.
Cross runway.
Taxi via runway.
Use of the RNP Runway 16R/16L:
This one is buried in the AIP. The RNPs are used for noise abatement between 15:00 – 19:00 LT in southerly conditions with good weather. The AIP states that all landing aircraft should be ready to shoot these approaches during this window. If your aircraft isn’t equipped, you need to let Tokyo approach know as early as possible. This may lead to a different runway allocation, or delays while a different approach is coordinated.
SID Suffixes:
In northerly winds, SIDs contain either an A, B, or C suffix. The initial waypoint for each suffix may vary so if you put the wrong one in the box, you may end up flying the wrong departure.
Highway Visual Runway 34R:
After getting an approach clearance, don’t cut straight to CACAO – fly the last assigned routing to CACAO unless ATC specifically tells you otherwise.
Speedy Turnoffs:
Like most busy airports, they want you off the runway pronto. Charts show the standard exits for each runway configuration and time of day.
So when is this three-strike thing actually happening?
Here’s where things are a little vague. We’ve been advised by reliable sources that informally, it already is. However the Airport Use Plan hasn’t been updated yet to include the PIC’s personal details. Assume it’s time to play ball – if a deviation occurs, JCAB will just ask for this info afterward.
SAFA Ramp Checks: What the 2025 Findings Are Really Telling Us
David Mumford
17 November, 2026
In our previous article, we looked at the SAFA findings that rarely make the crew briefing: EFB mounts, MEL customization, maintenance due dates, placards and the other details hiding behind the inspection checklist.
Following that article, the EASA Ramp Coordination team shared its 2025 inspection data with us (although EASA did not commission or endorse this article!). It shows that many of the most common problems were routine issues that could have been caught before the inspection.
So here’s a look at what inspectors found, and what crews can do to avoid the same problems.
If the inspector can see it, the log should explain it
A recurring significant finding involved defects that had not been properly identified, assessed or monitored. Inspectors also found maintenance actions that were not properly recorded.
Anything found on the walkaround should be properly covered in the tech log. Staining, damage, loose panels and other visible defects should have been assessed, deferred, monitored or fixed. If an inspector can see it, expect them to check the paperwork.
“Cabin ready” means ready for flight
The more serious findings included unsecured cabin equipment, blocked emergency-exit access, poorly restrained cargo and maintenance work that did not follow the applicable MEL, Aircraft Maintenance Manual or Structural Repair Manual instructions.
Some of that can be caught during a final cabin and cargo sweep. Some of it needs maintenance control long before departure. Better to know which is which before the inspector asks!
For GA, the inspection starts at the planning desk
For business aviation, the main findings included unsuitable or insufficient alternates, missed Notams, and missing or seriously incorrect performance or fuel calculations.
They also found crews carrying an MMEL instead of an MEL, MELs that were not fully customized, outdated or incomplete manuals, mismatched checklists, old navigation databases and required charts that were unavailable when needed.
EASA’s Ramp Coordination team confirmed that the SAFA-GA Top 5 includes findings from all three categories, not just Category 3. For GA crews, flight planning and document control are among the main areas to check before an inspection.
Before your next trip to Europe
Match visible aircraft defects to the tech log and any maintenance or deferral action.
Check the MEL is the operator’s current, usable document – not an MMEL wearing a new cover.
Recheck alternates, Notams, fuel, performance and both flight plans.
Verify the ATC flight plan Item 10 equipment and surveillance codes against the aircraft’s installed, serviceable and approved capabilities.
Cross-check Item 18 entries – including PBN/, NAV/, COM/, DAT/, SUR/, REG/ and OPR/ when applicable – and make sure OPR/ identifies the actual operating agency, not automatically the management or flight-planning company.
Confirm manuals, checklists, navigation data and required charts are current and available.
Check the cabin, emergency exits and cargo areas for anything likely to result in a finding.
Run your own ramp check first
Carry out an internal ramp check using one of your aircraft and an actual trip. Work through each inspection area, record any discrepancies, assign responsibility and confirm they have been closed. That is a simple internal Ramp Inspection Program.
A ramp inspection covers much more than the condition of the aircraft. Inspectors will also check the flight plan, MEL, tech log, manuals, cabin and cargo, so make sure everything is current and consistent before departure.
EASA does not mediate or decide disagreements over individual findings. Each finding remains the inspecting authority’s responsibility and is subject to that state’s normal appeal process. EASA also provides information to IBAC annually, and IBAC members may contact IBAC.
